Rendering of Chapel View Care Center

Chapel View Care Center Construction Updates

January 2026:

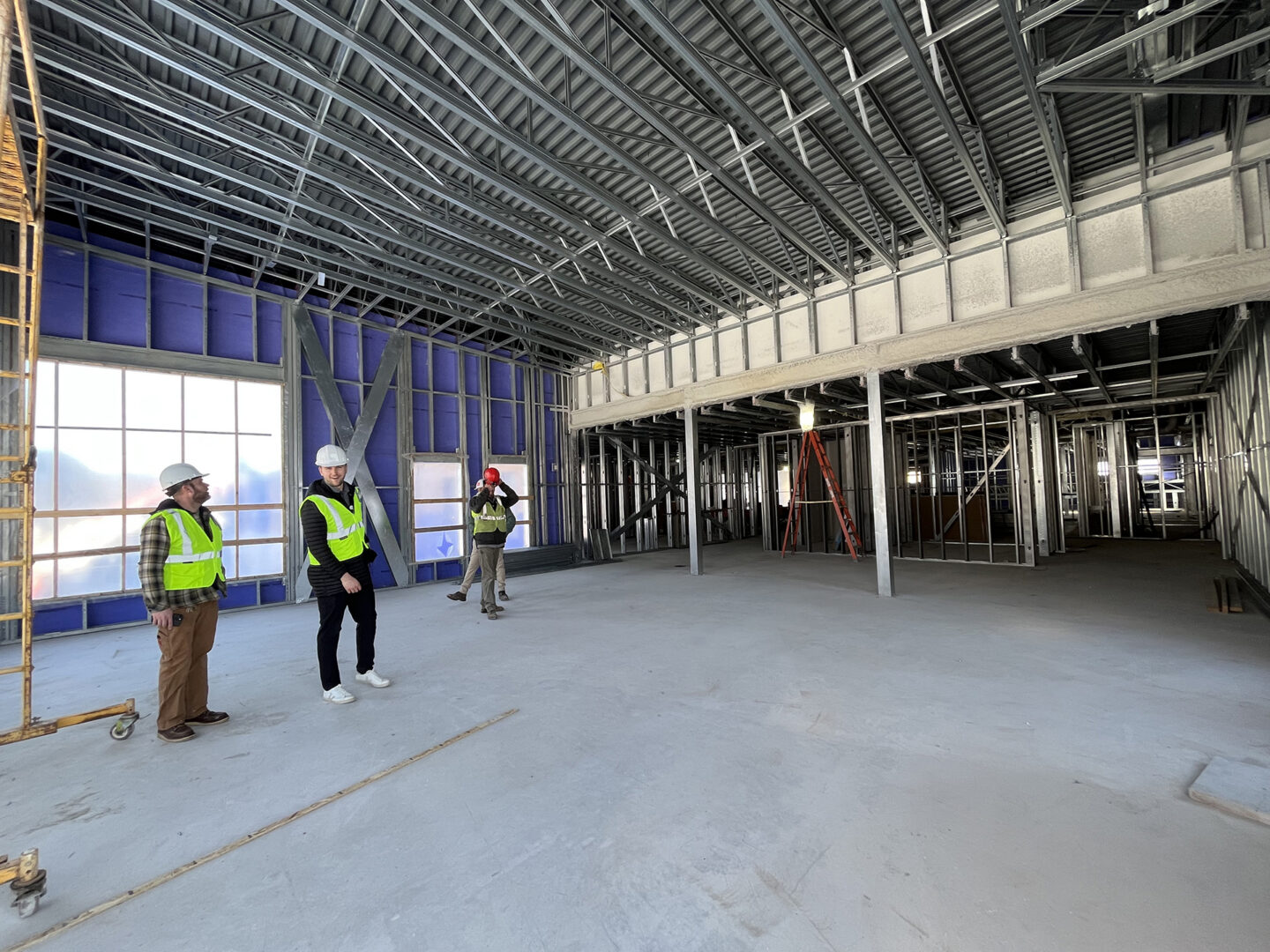

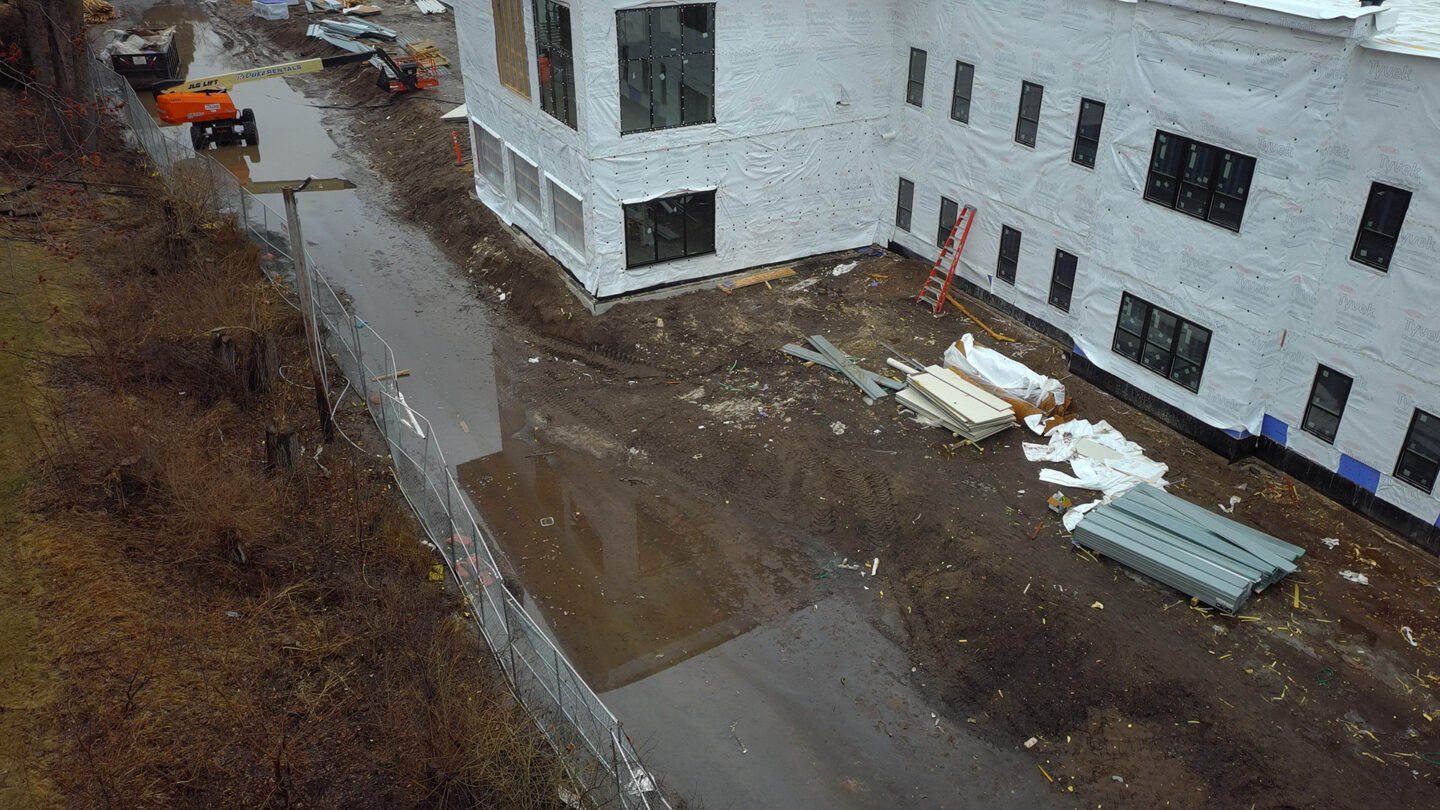

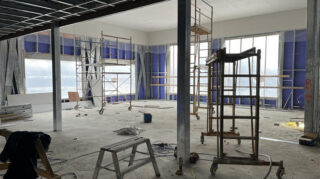

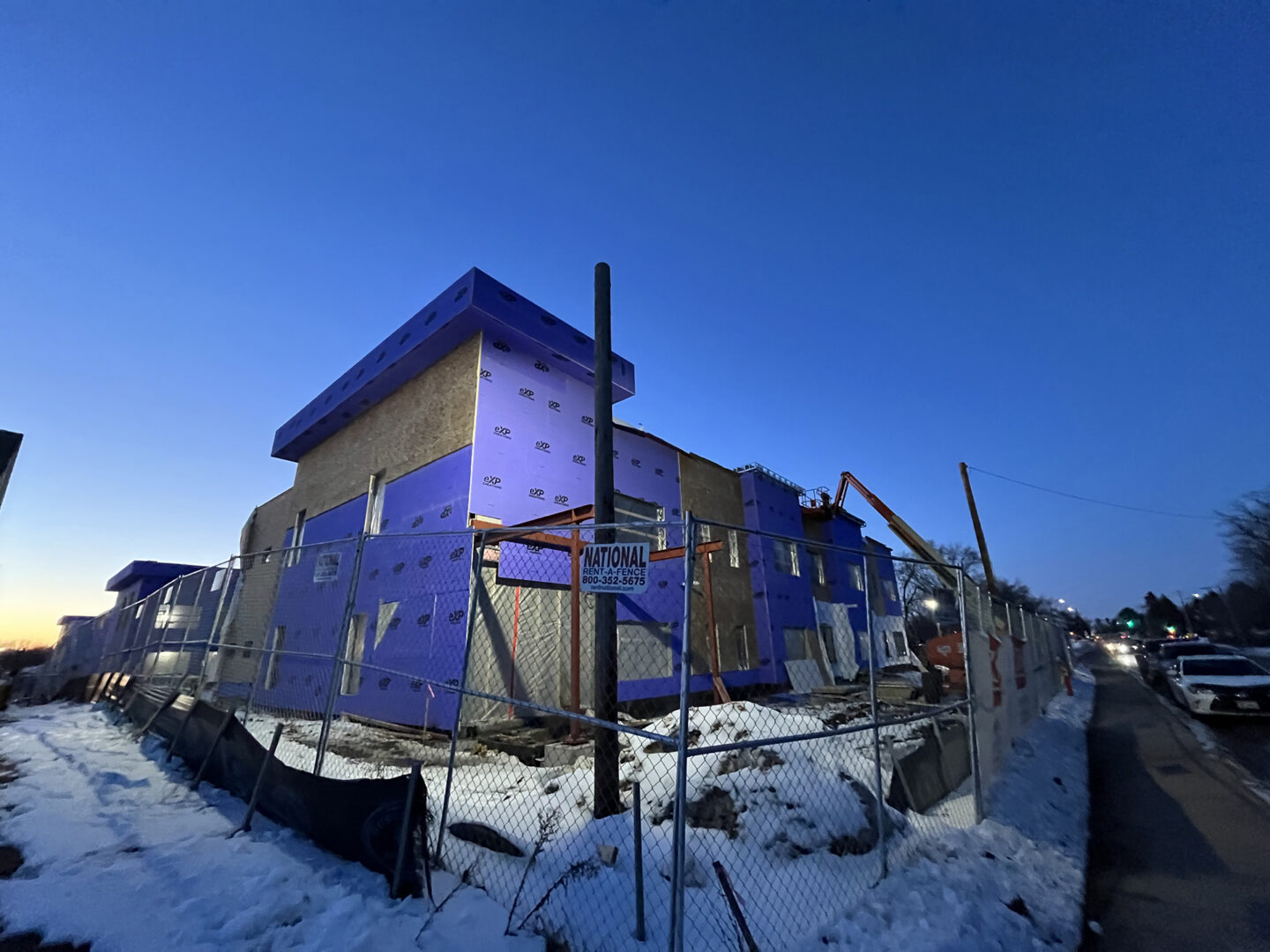

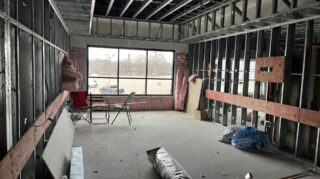

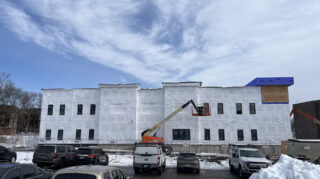

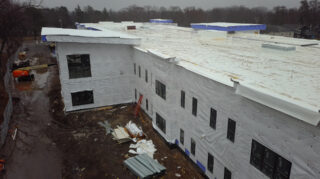

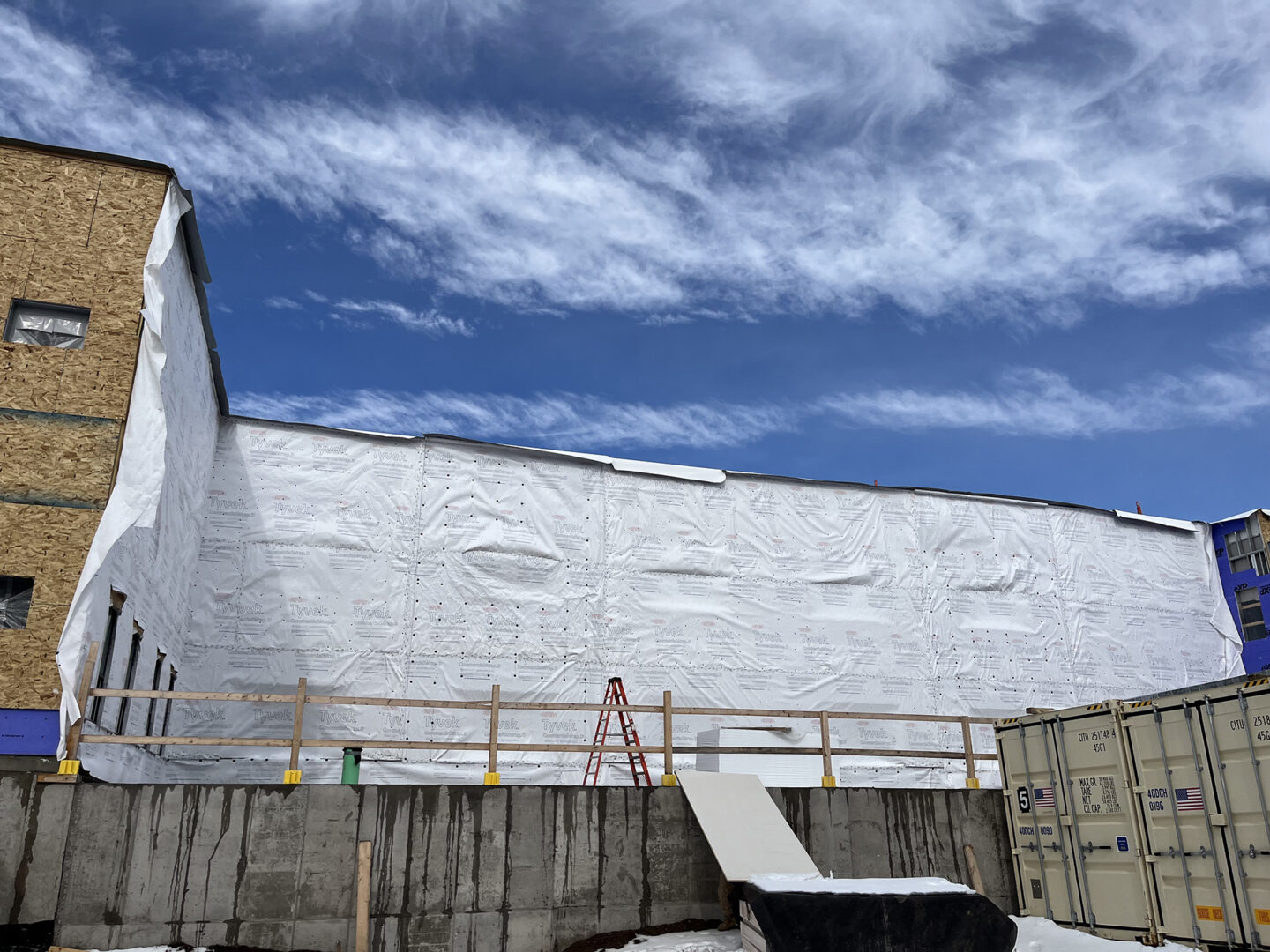

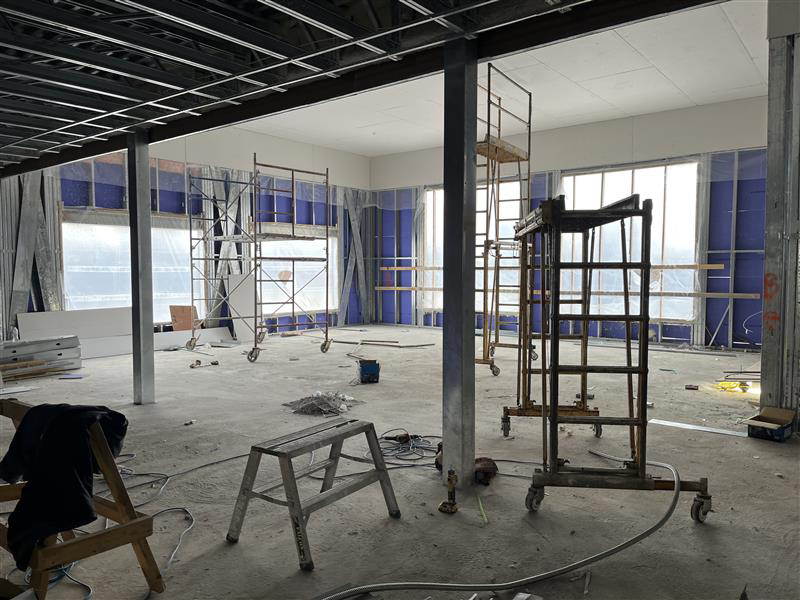

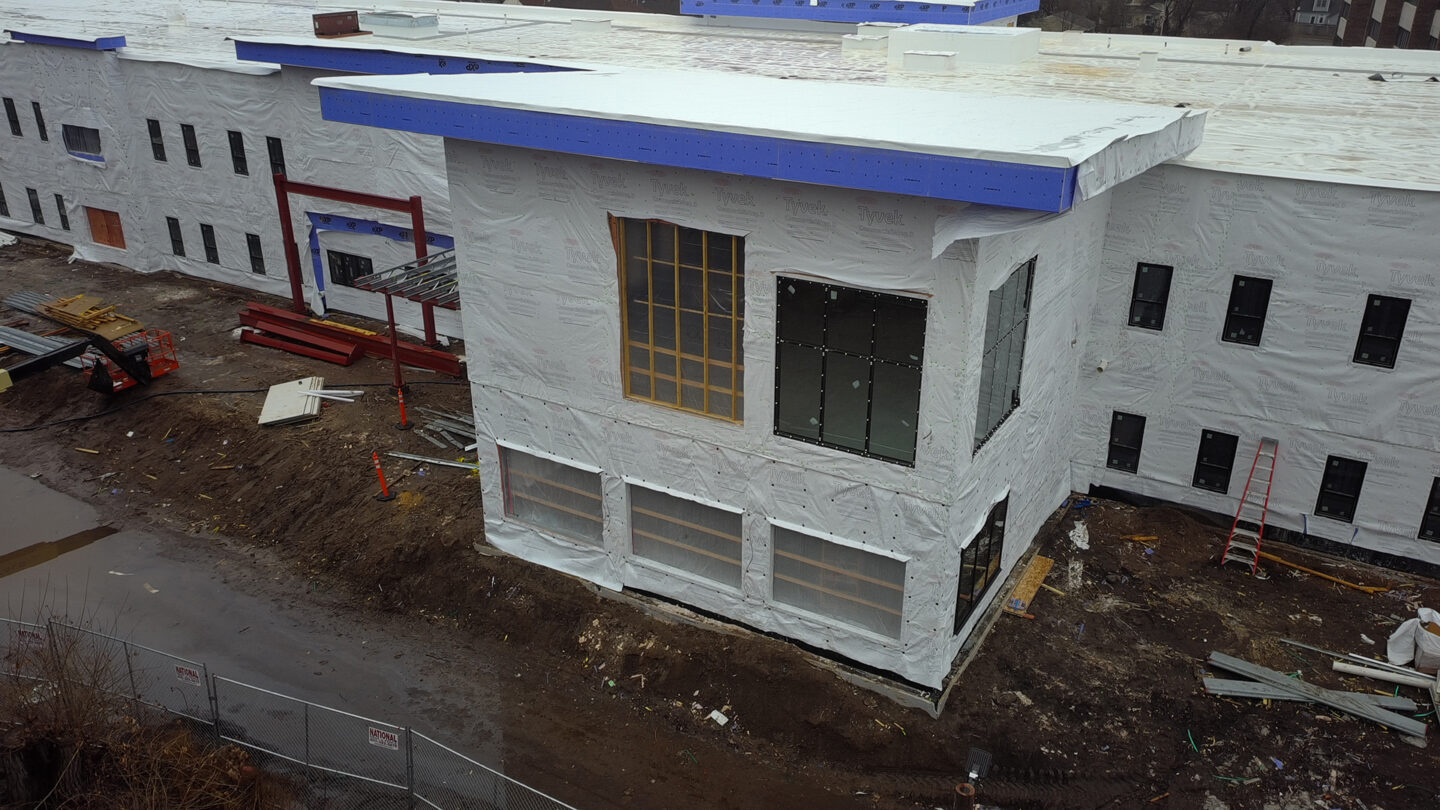

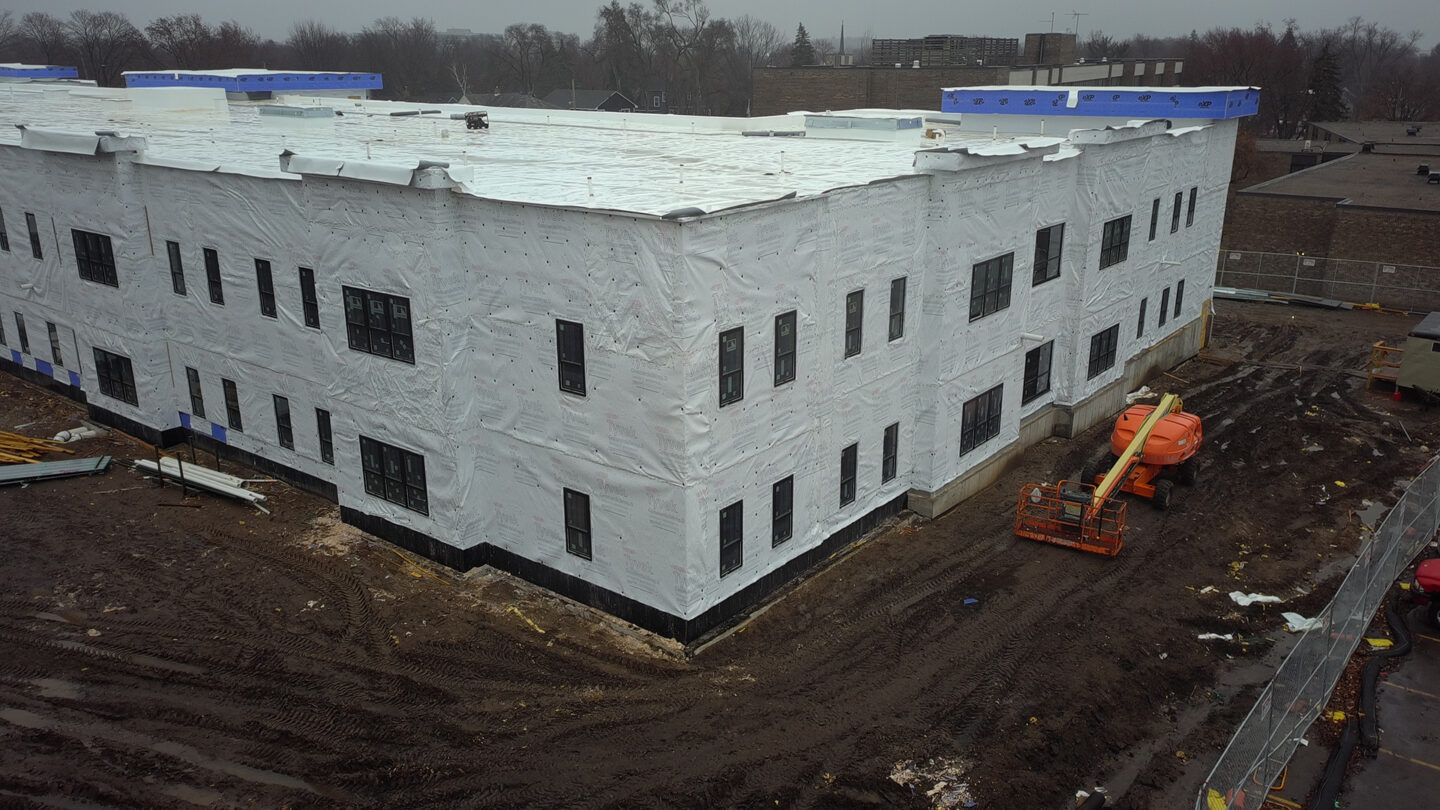

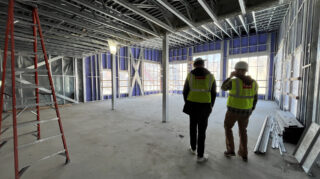

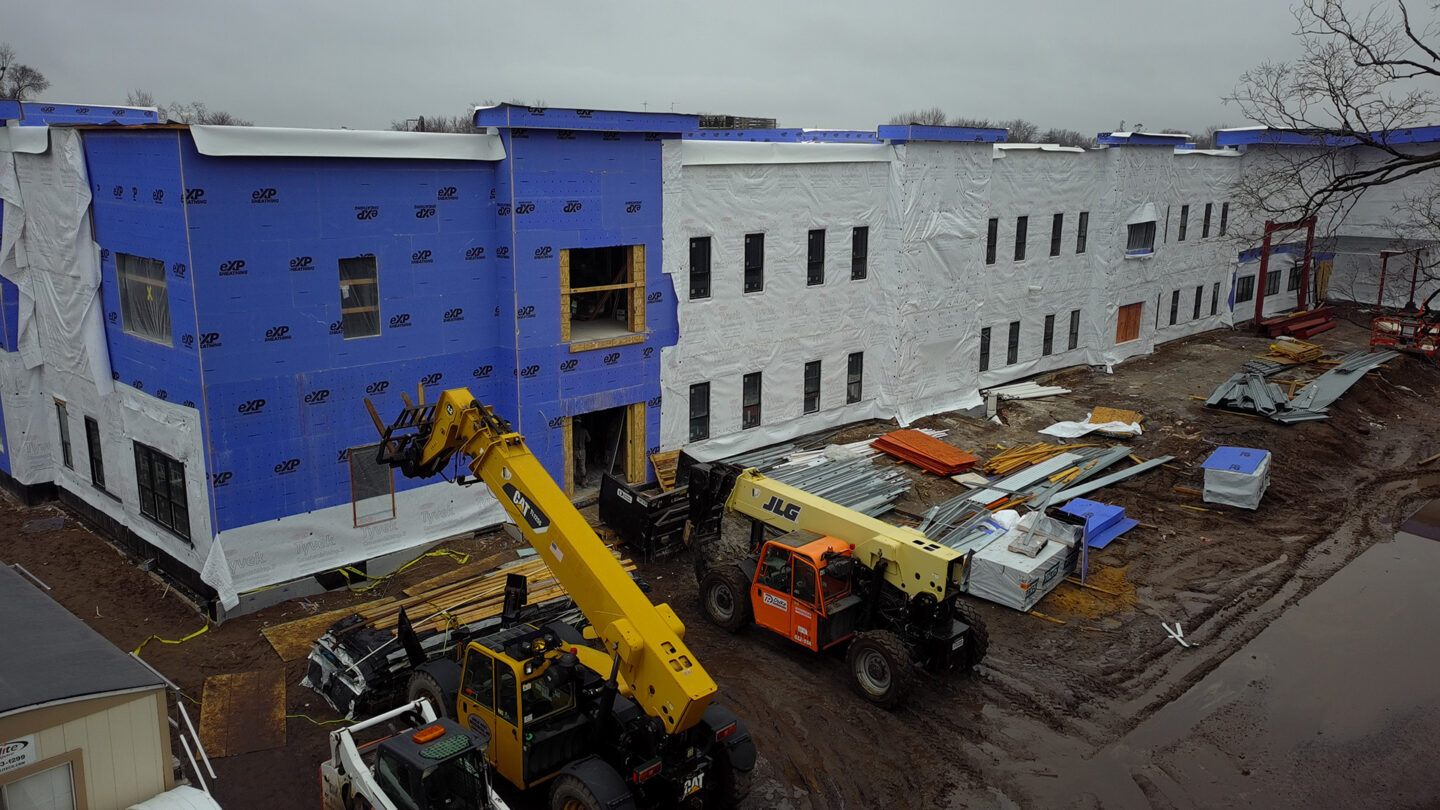

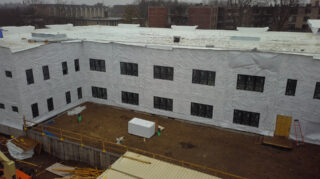

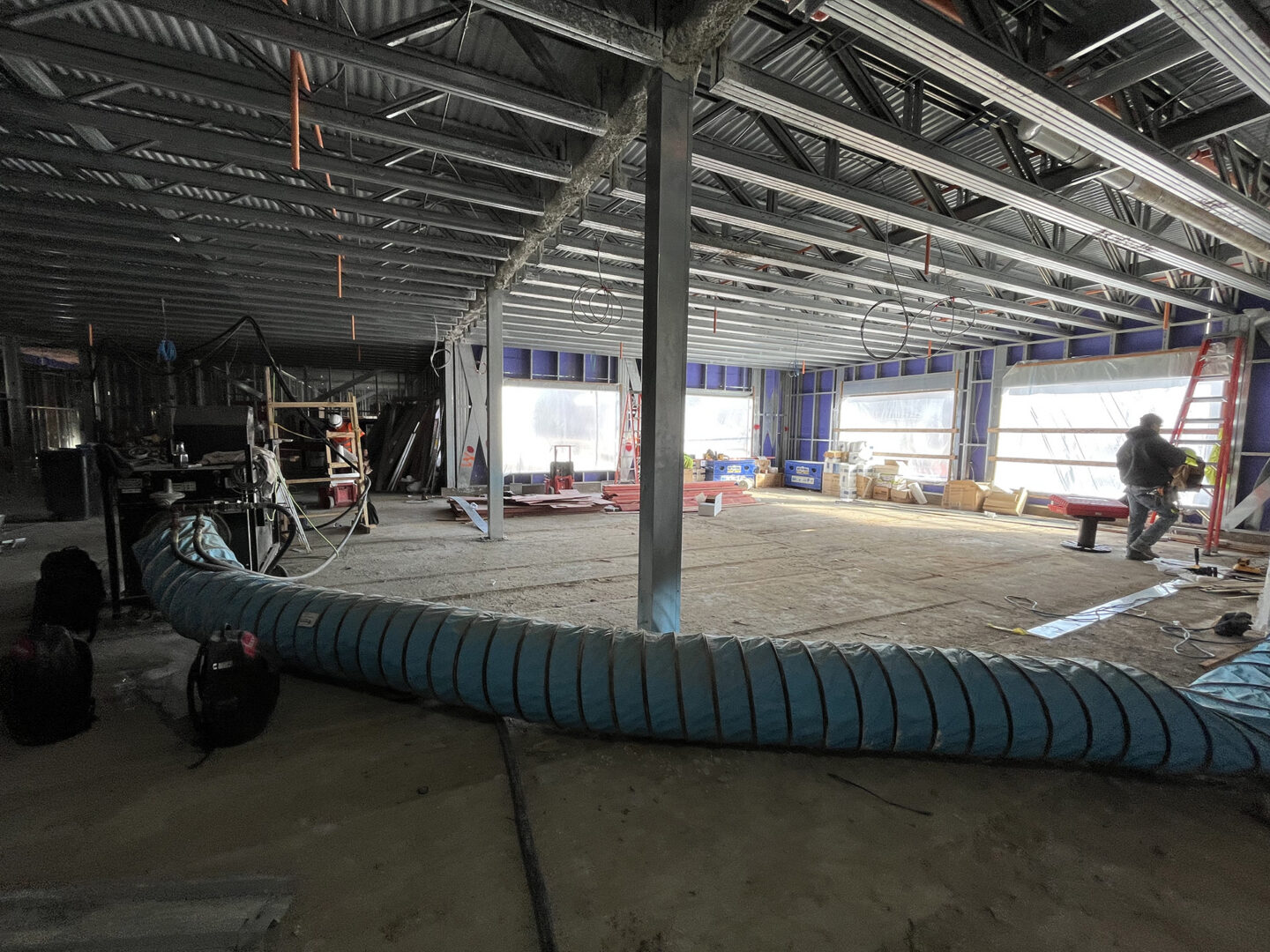

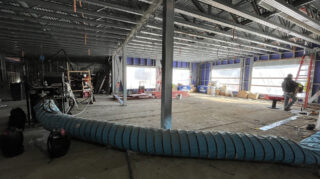

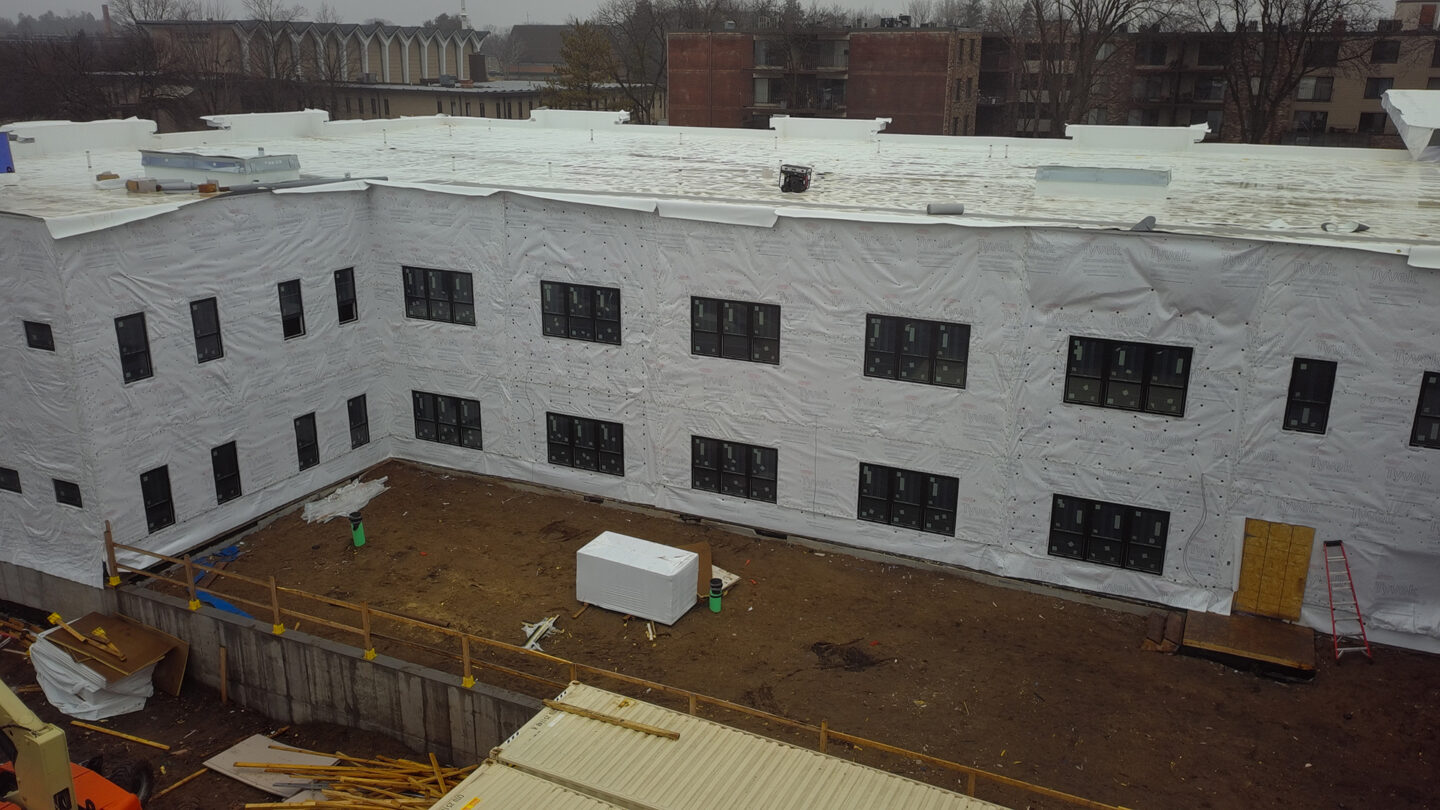

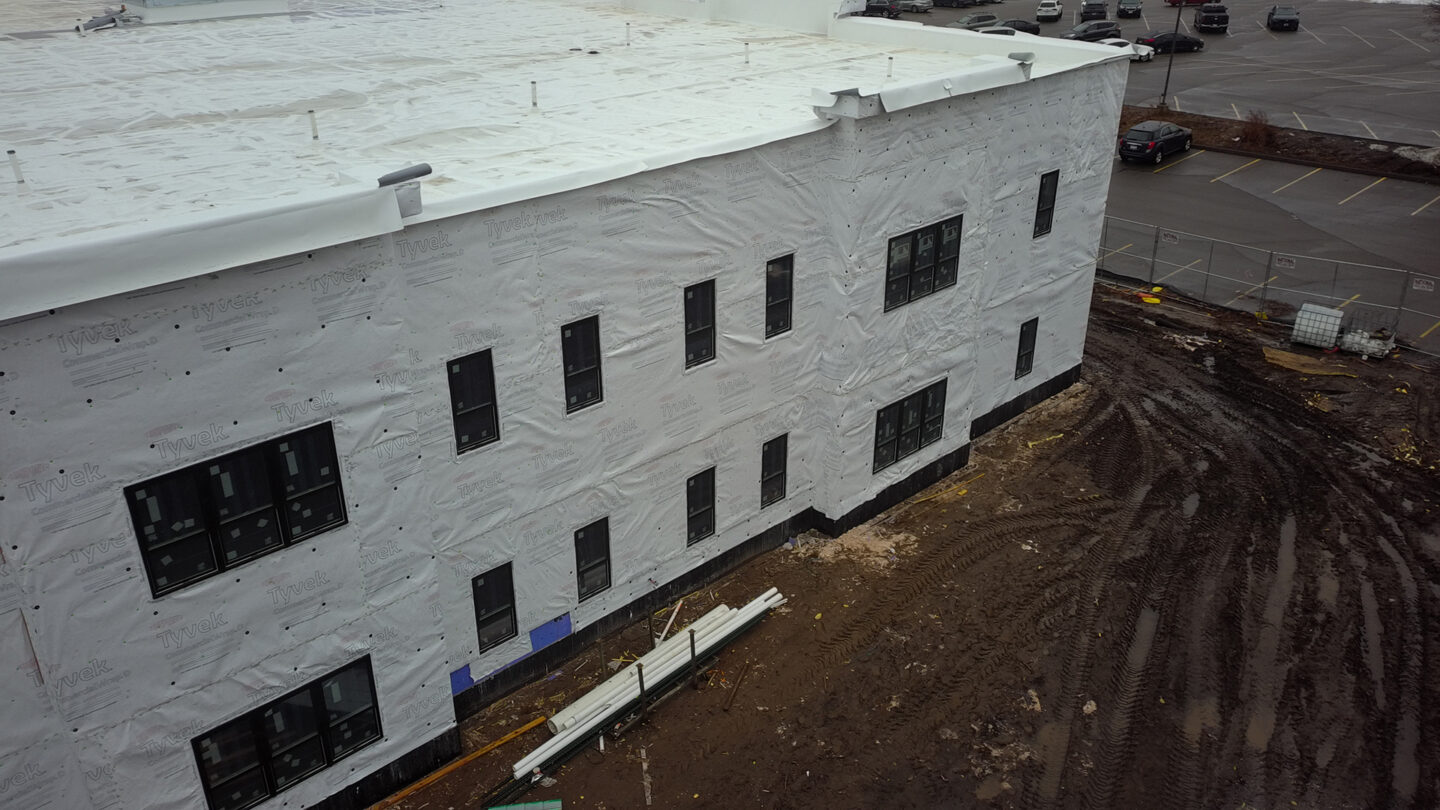

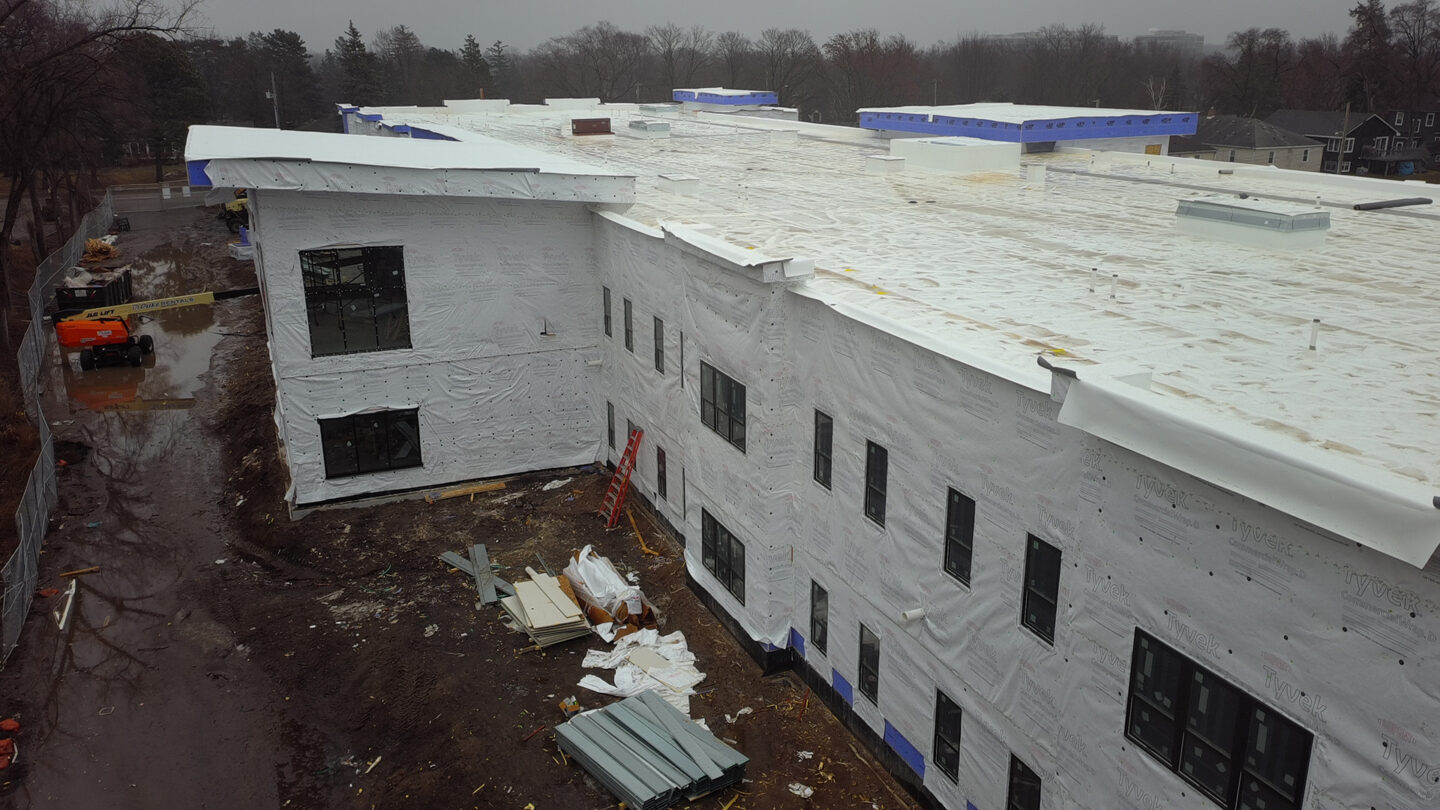

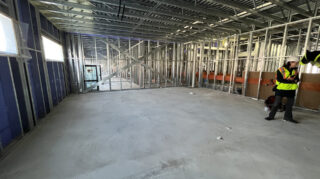

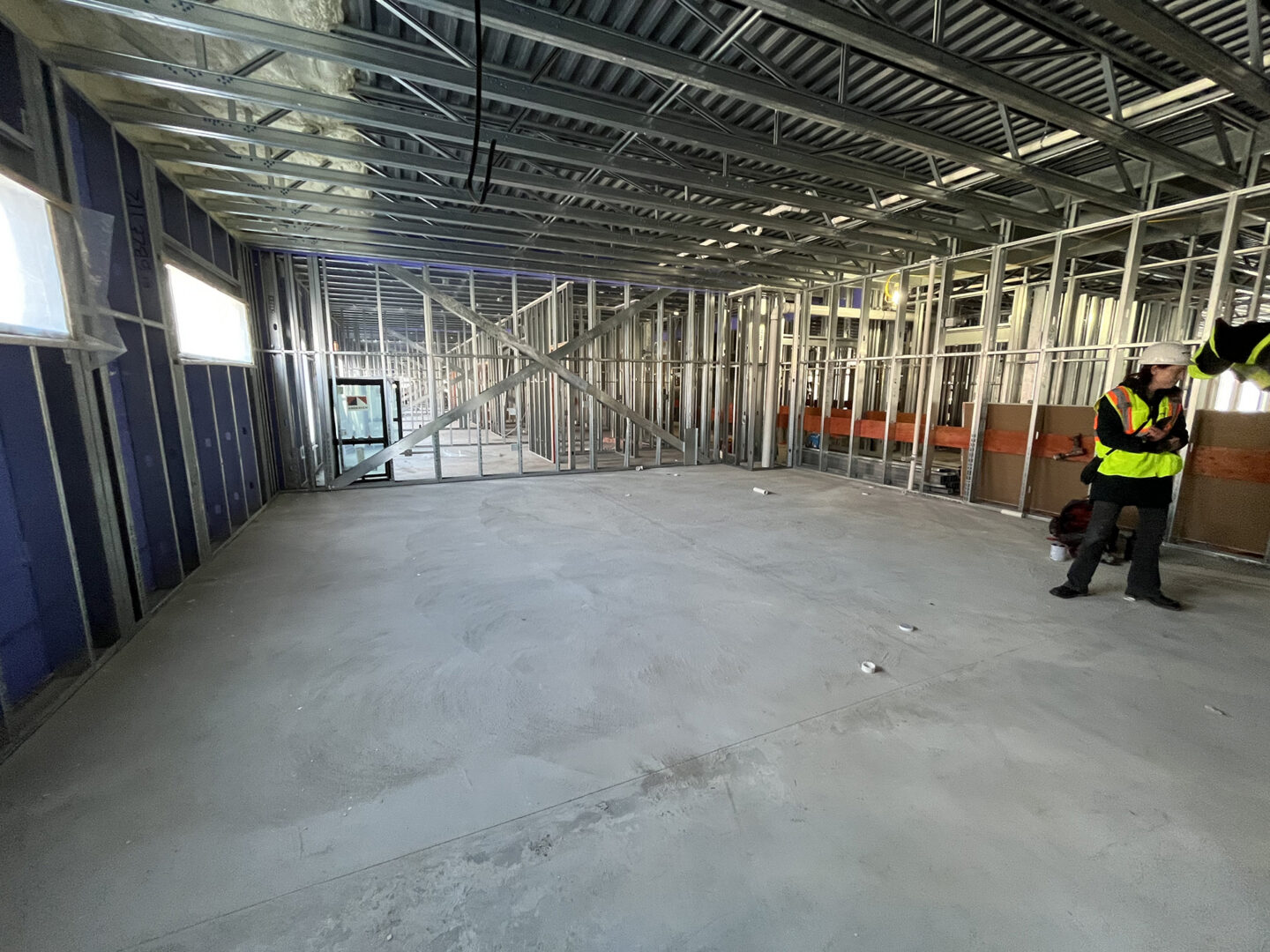

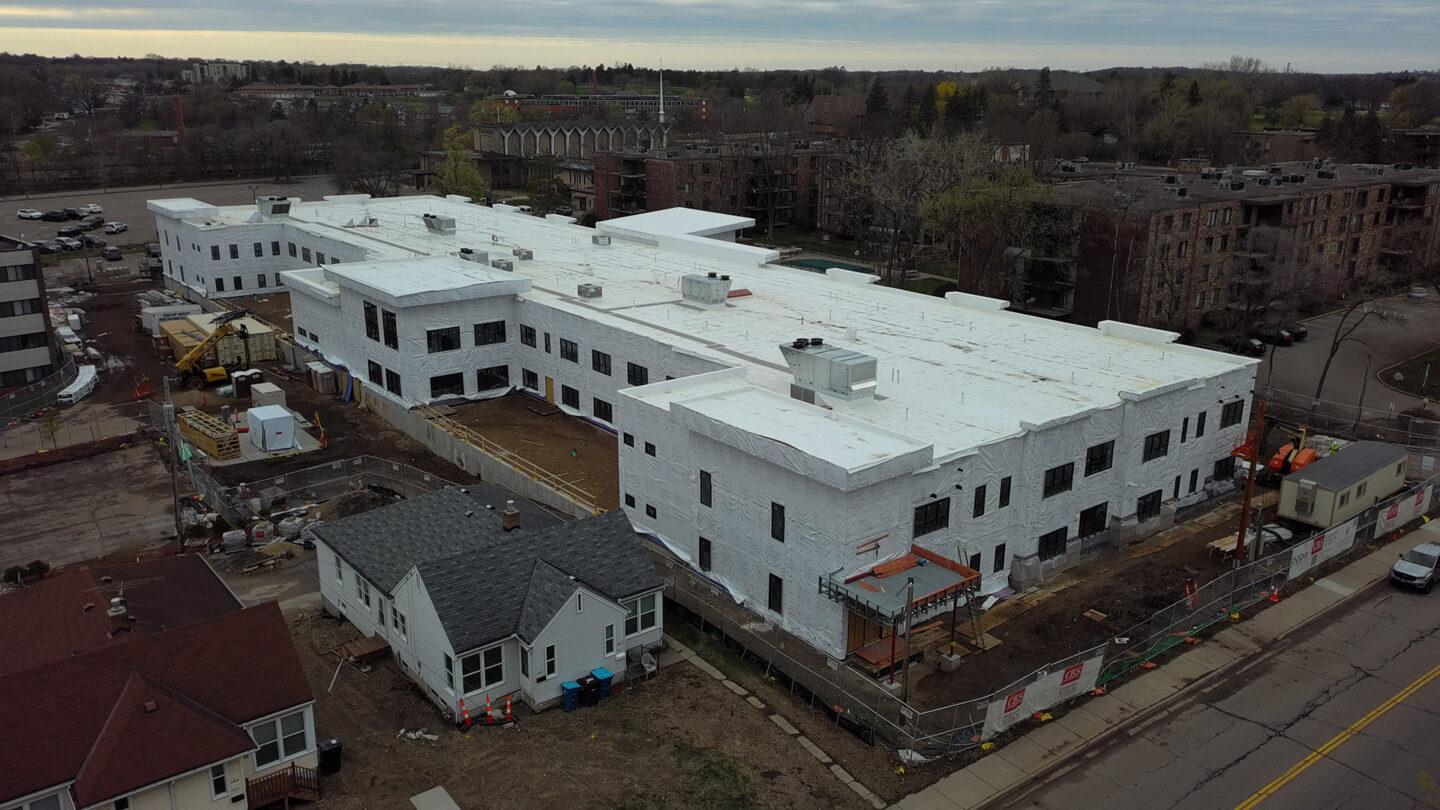

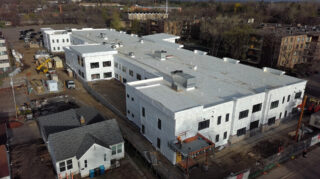

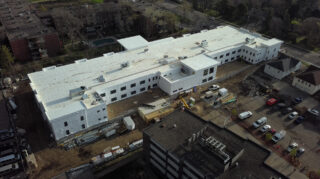

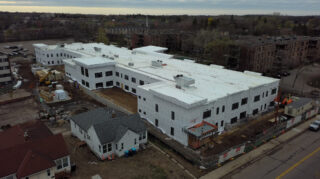

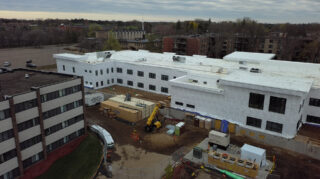

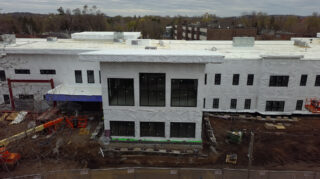

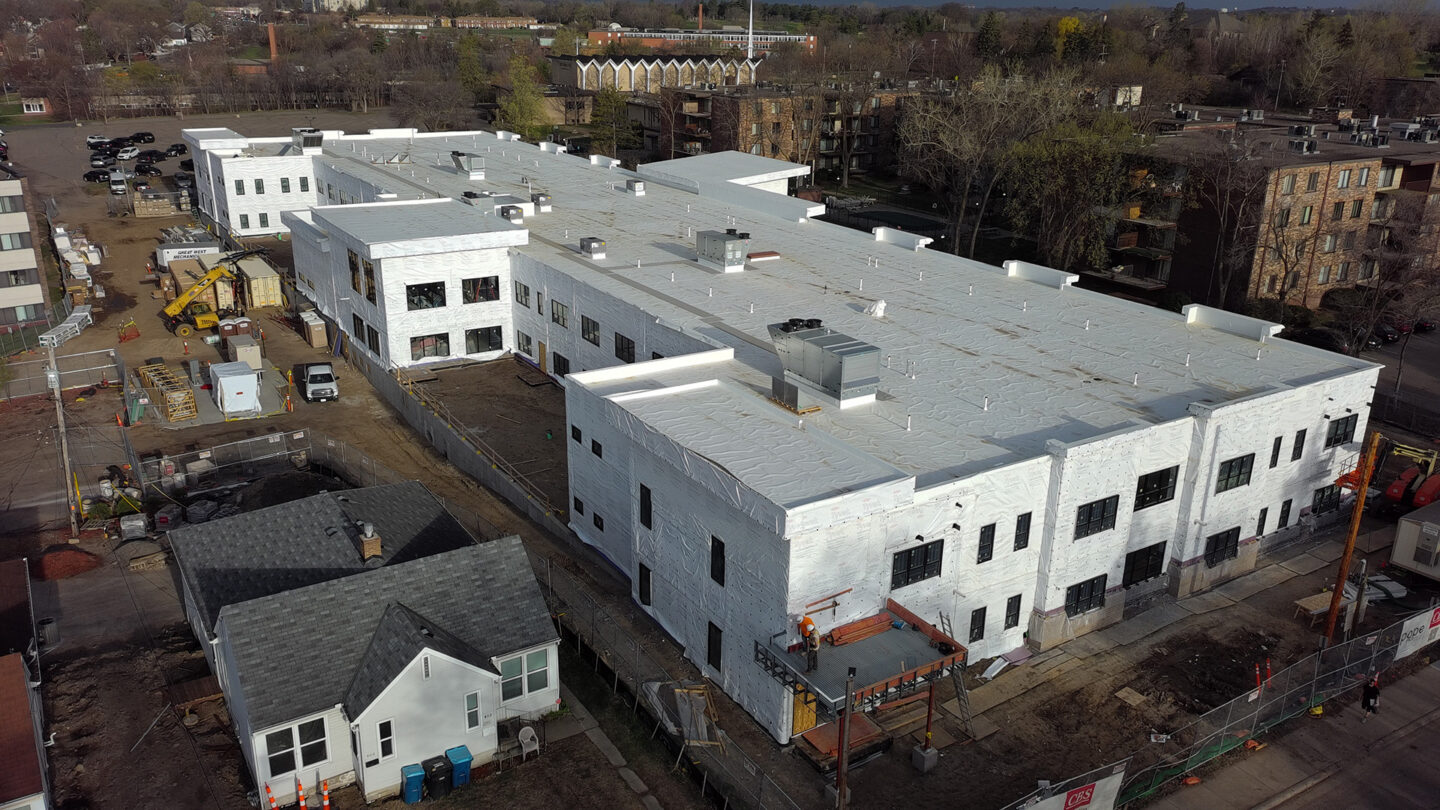

CBS Construction remains on track for a Fall 2026 substantial completion of the new Chapel View Care Center in Hopkins, MN. Roof installation remains the priority, scheduled for early 2026. Despite a snowier-than-average December, the project is progressing well, with successful completion of the second-floor concrete pour. While the concrete finishing took longer than anticipated, framing on both the first and second floors has advanced significantly, and roof assembly is beginning to take shape.

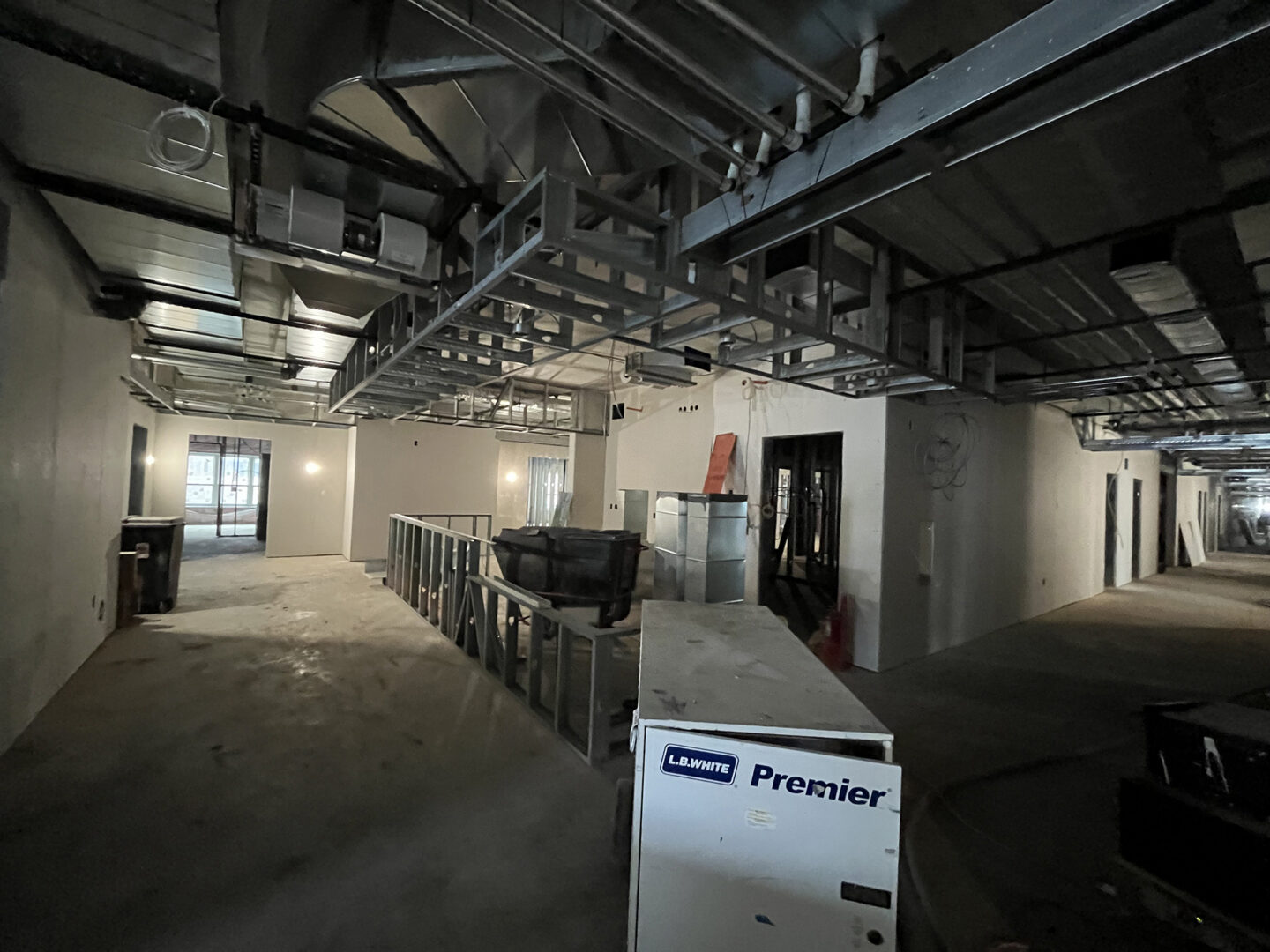

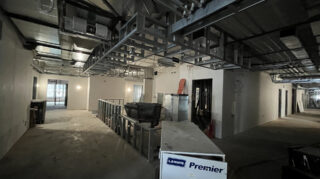

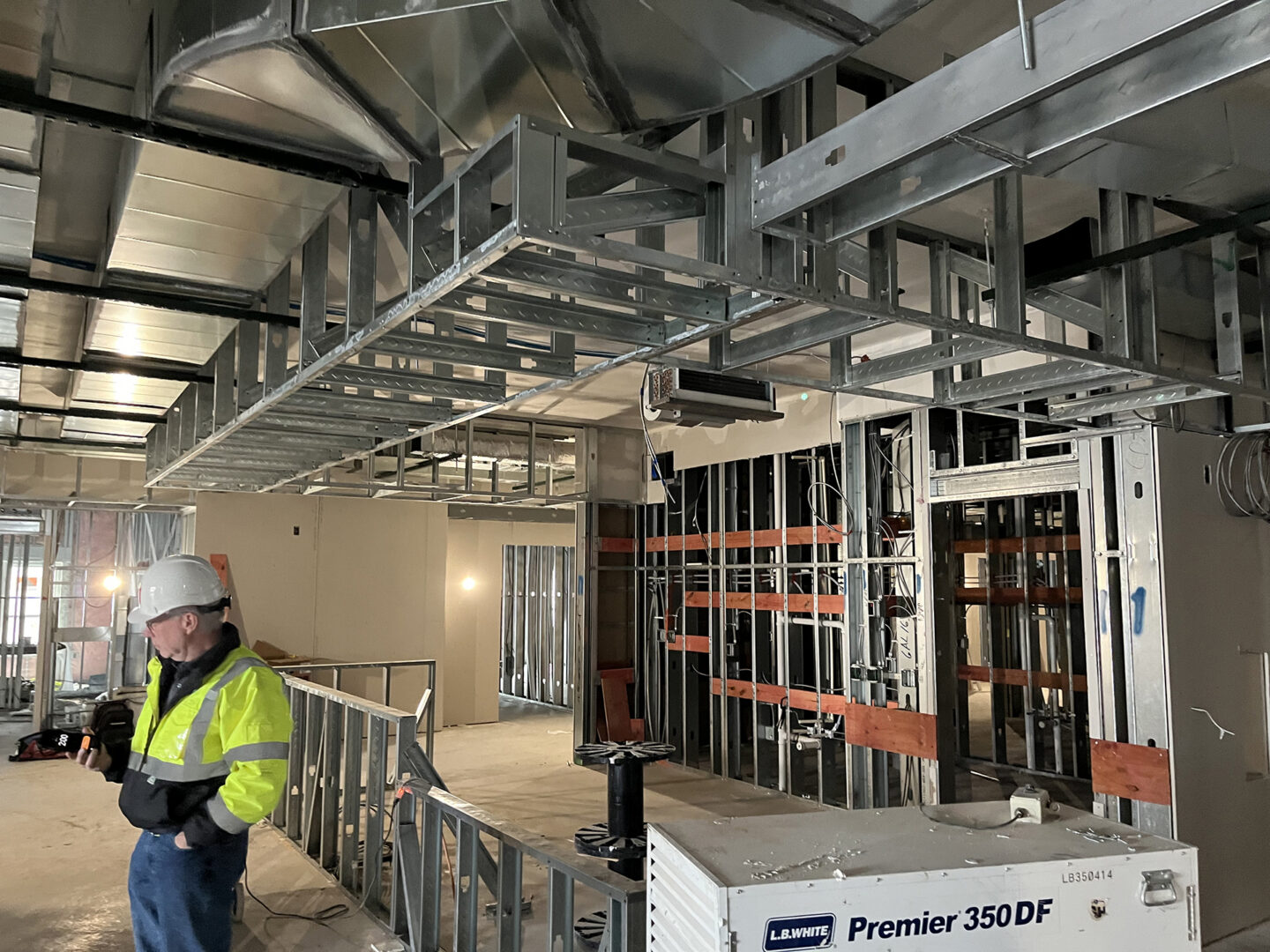

Our plumbing, electrical and mechanical partners are making excellent progress where possible, with anticipation that the building will be dried in soon. Key activities currently in progress include:

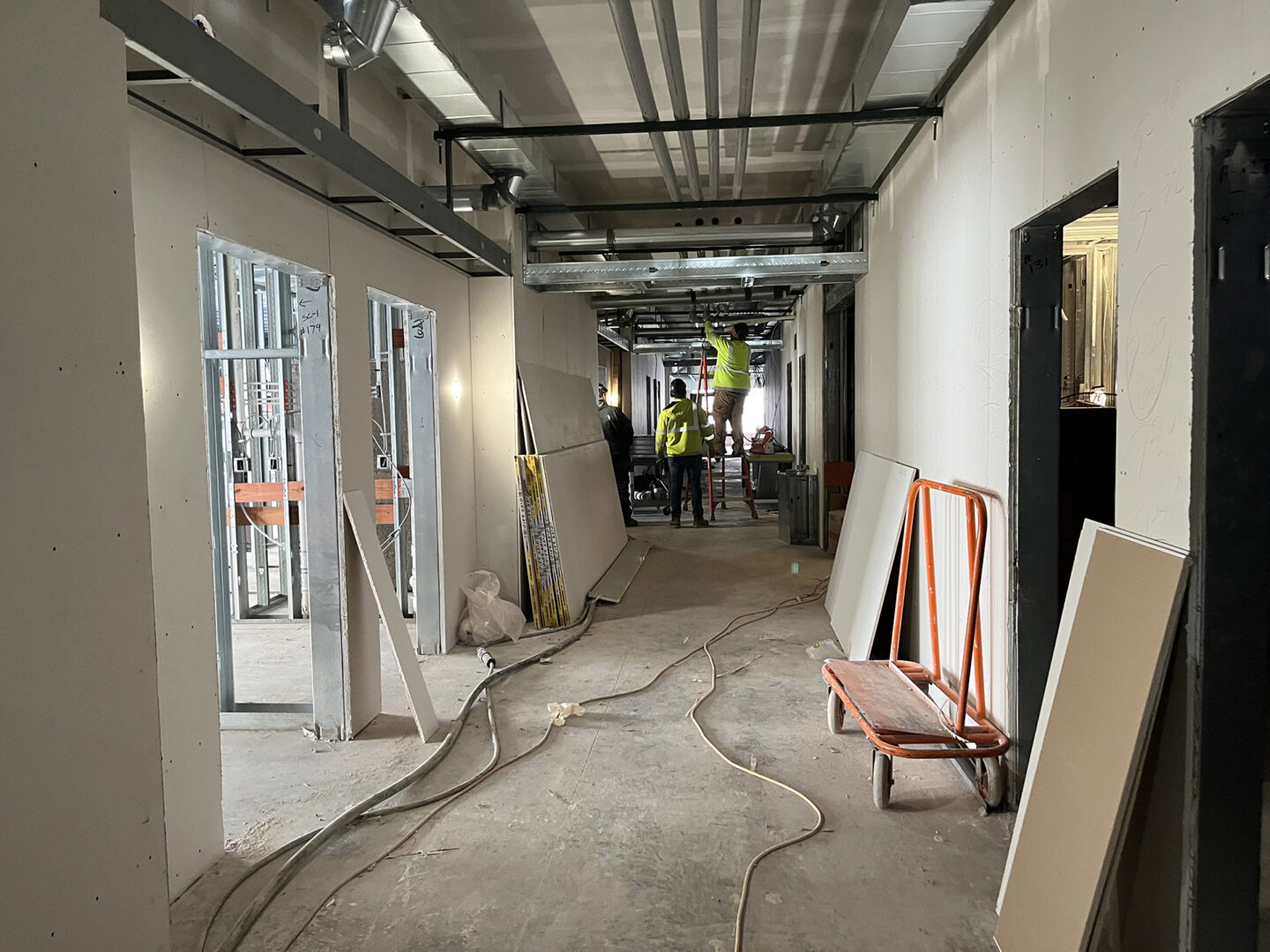

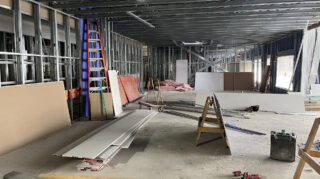

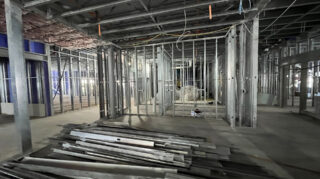

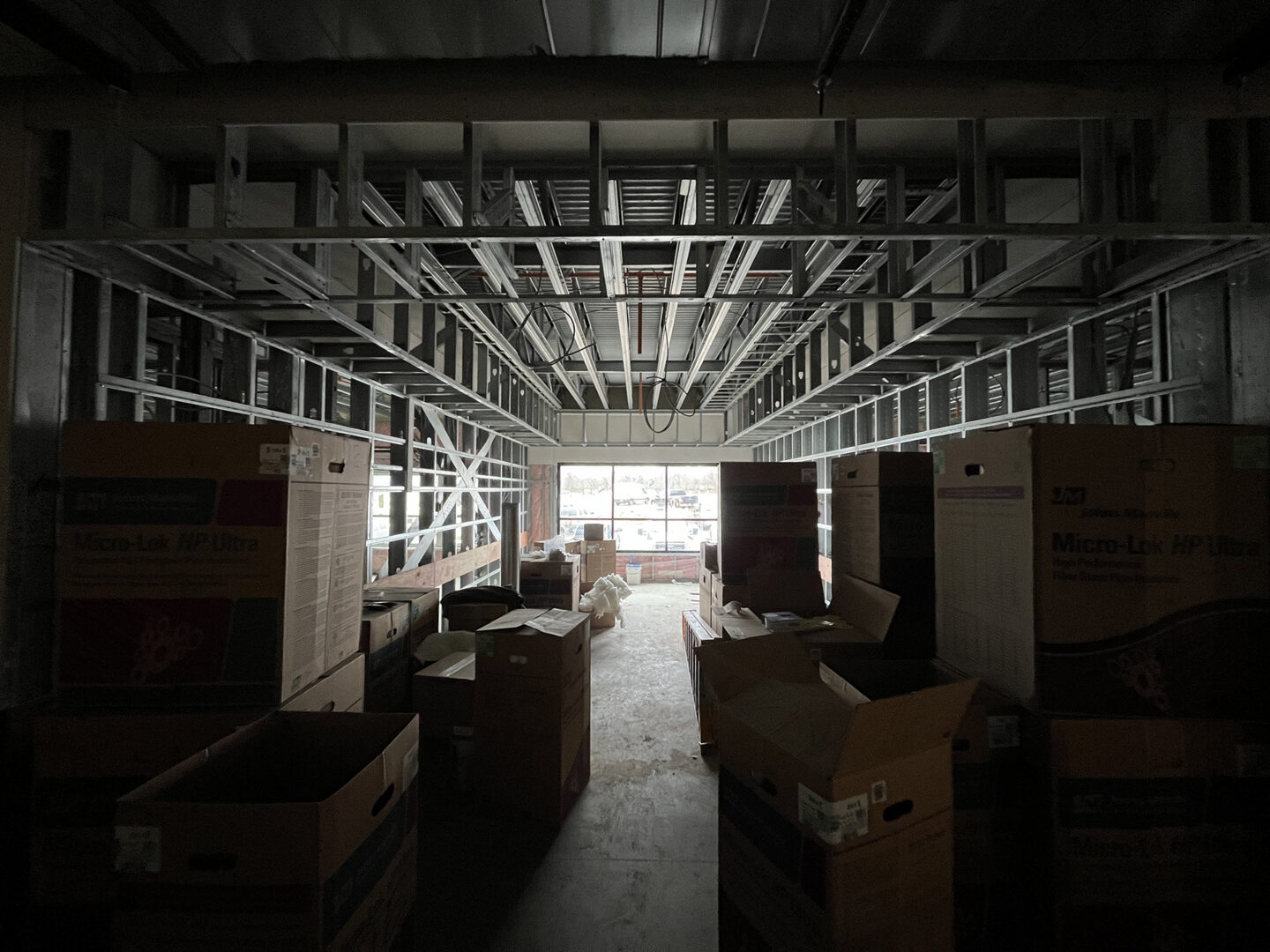

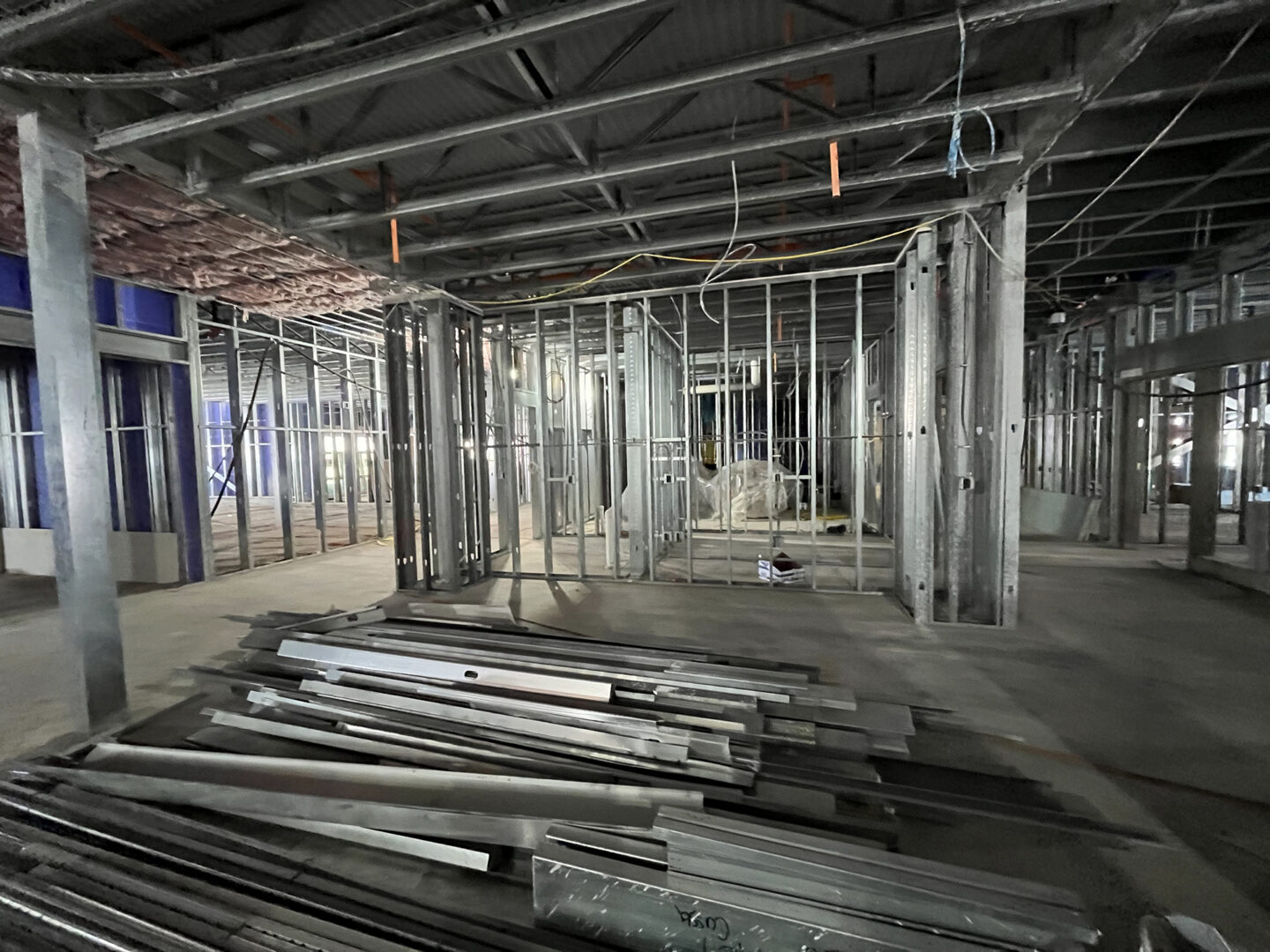

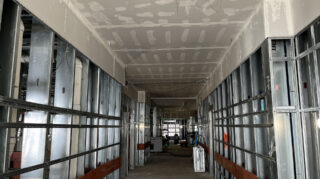

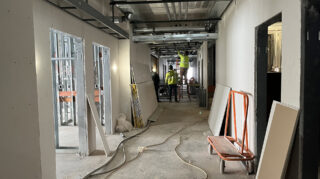

  • First-floor wall installation – 90% complete

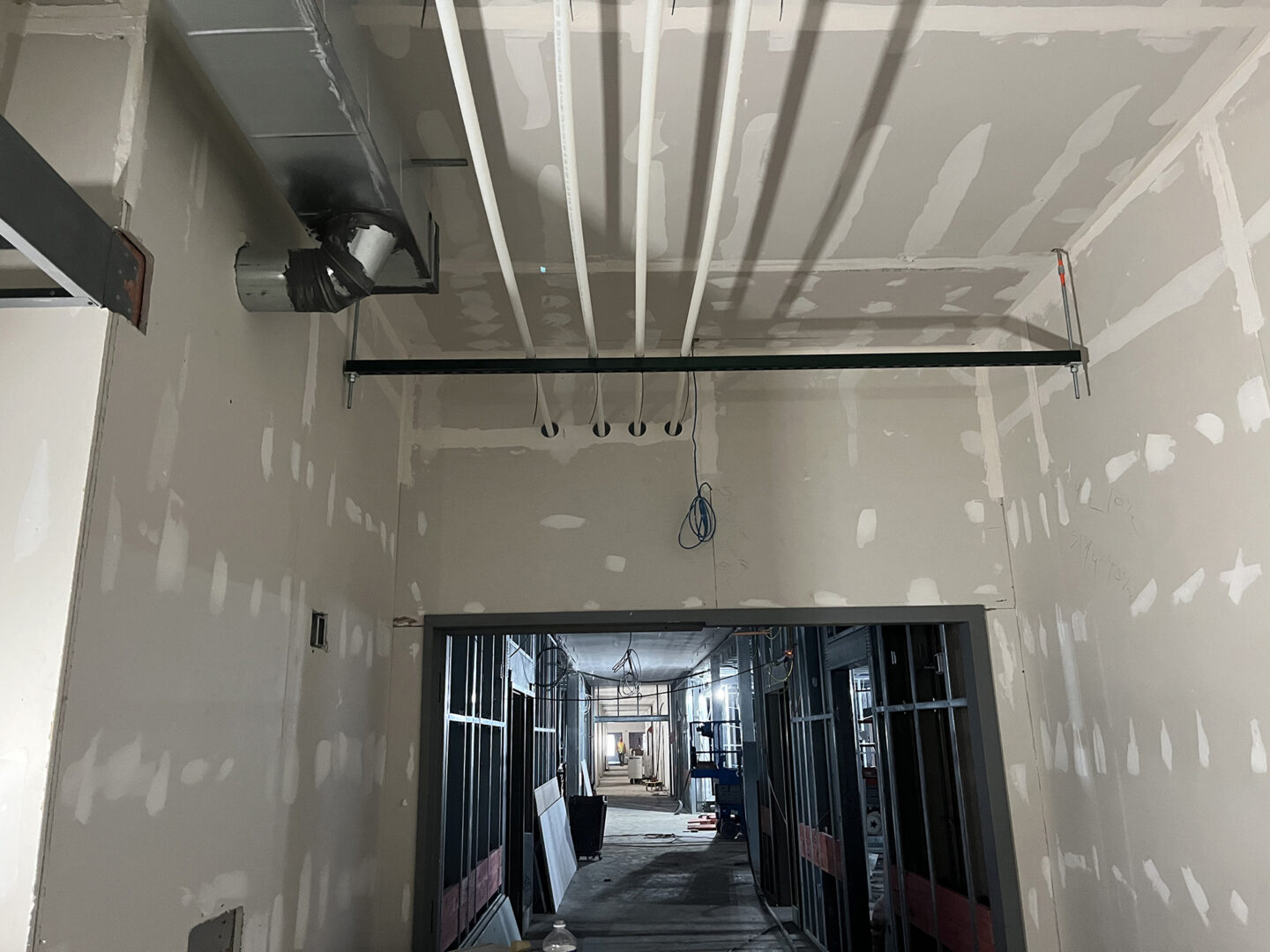

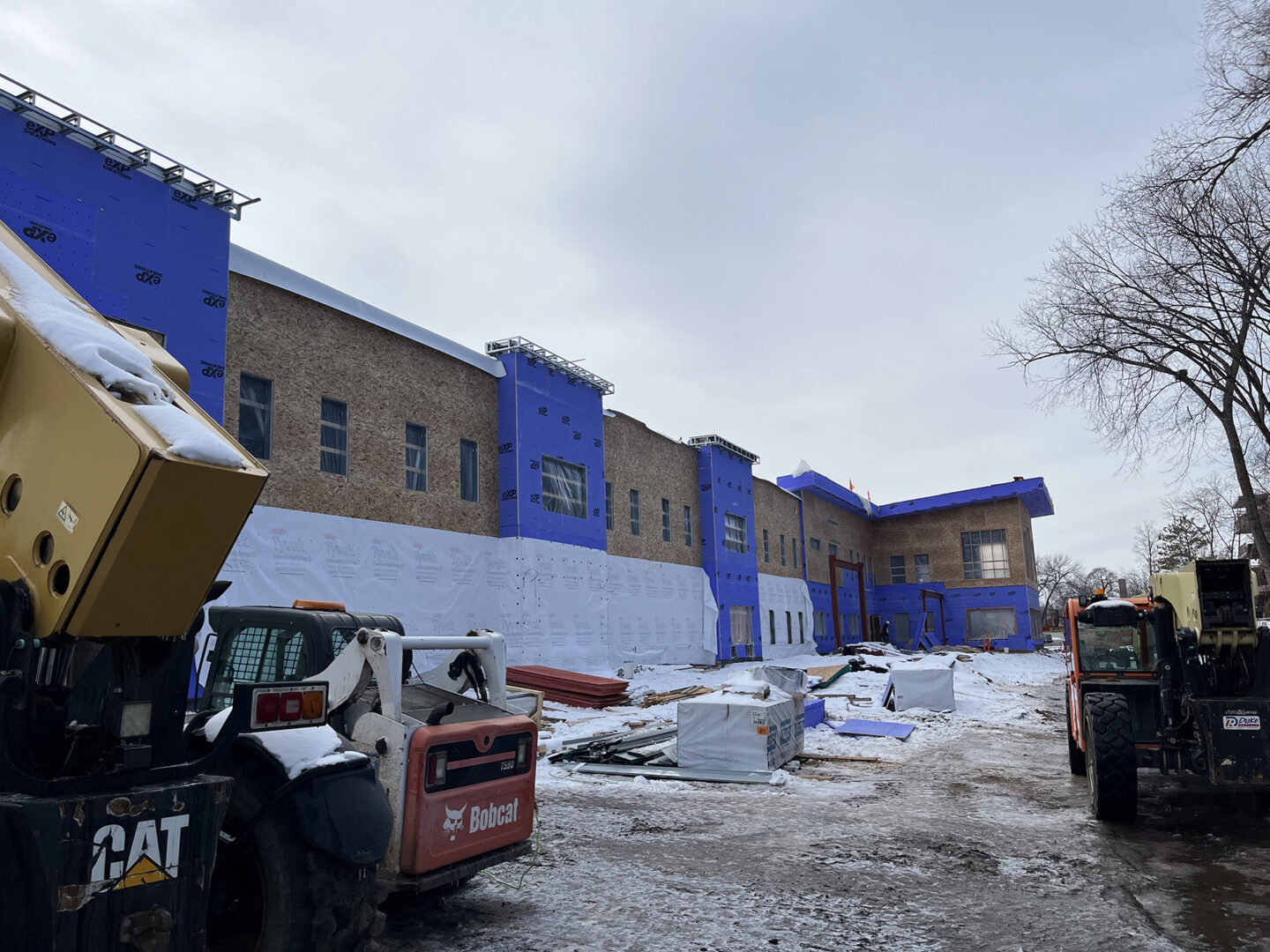

  • Exterior sheathing – 30% complete

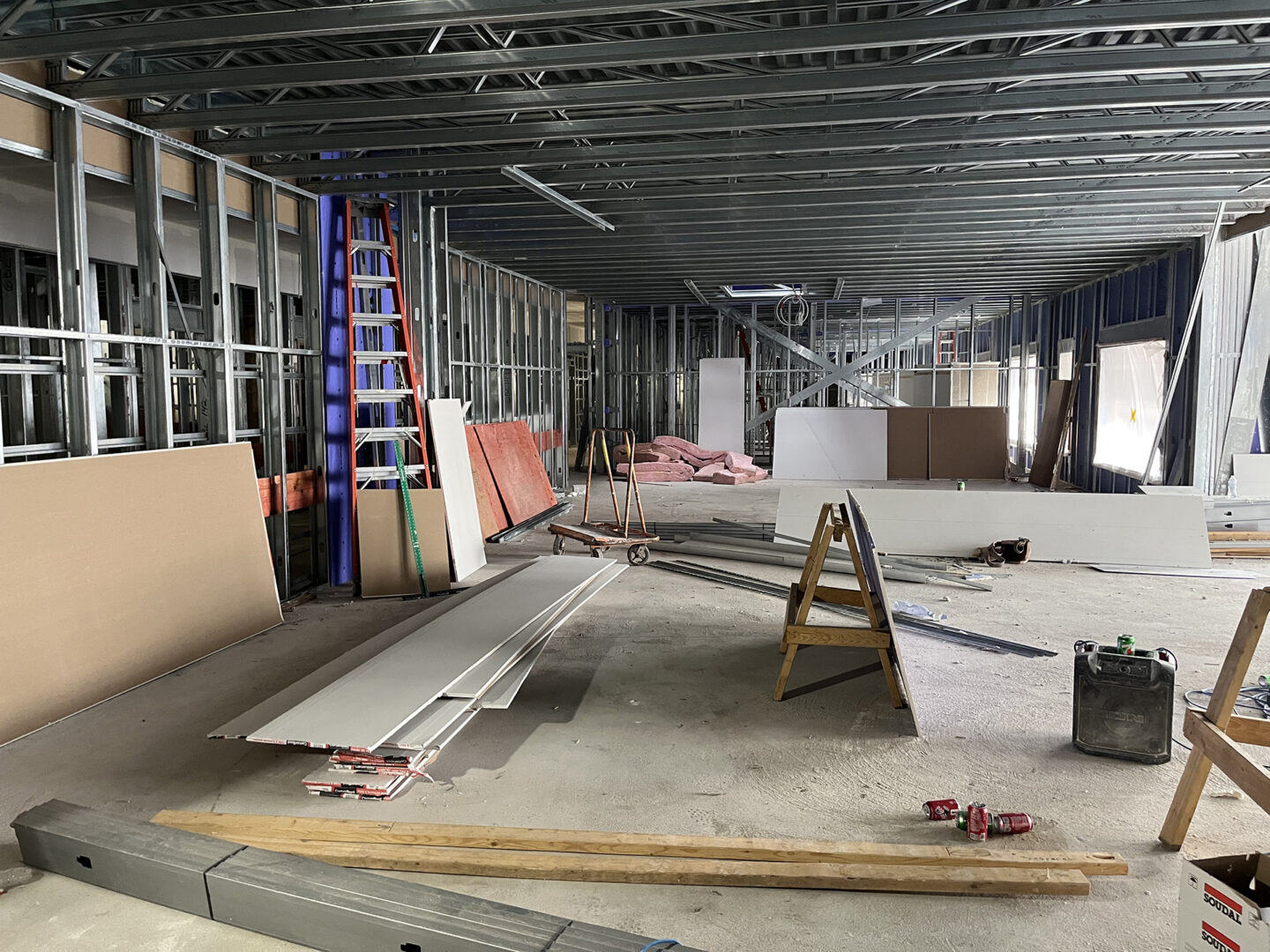

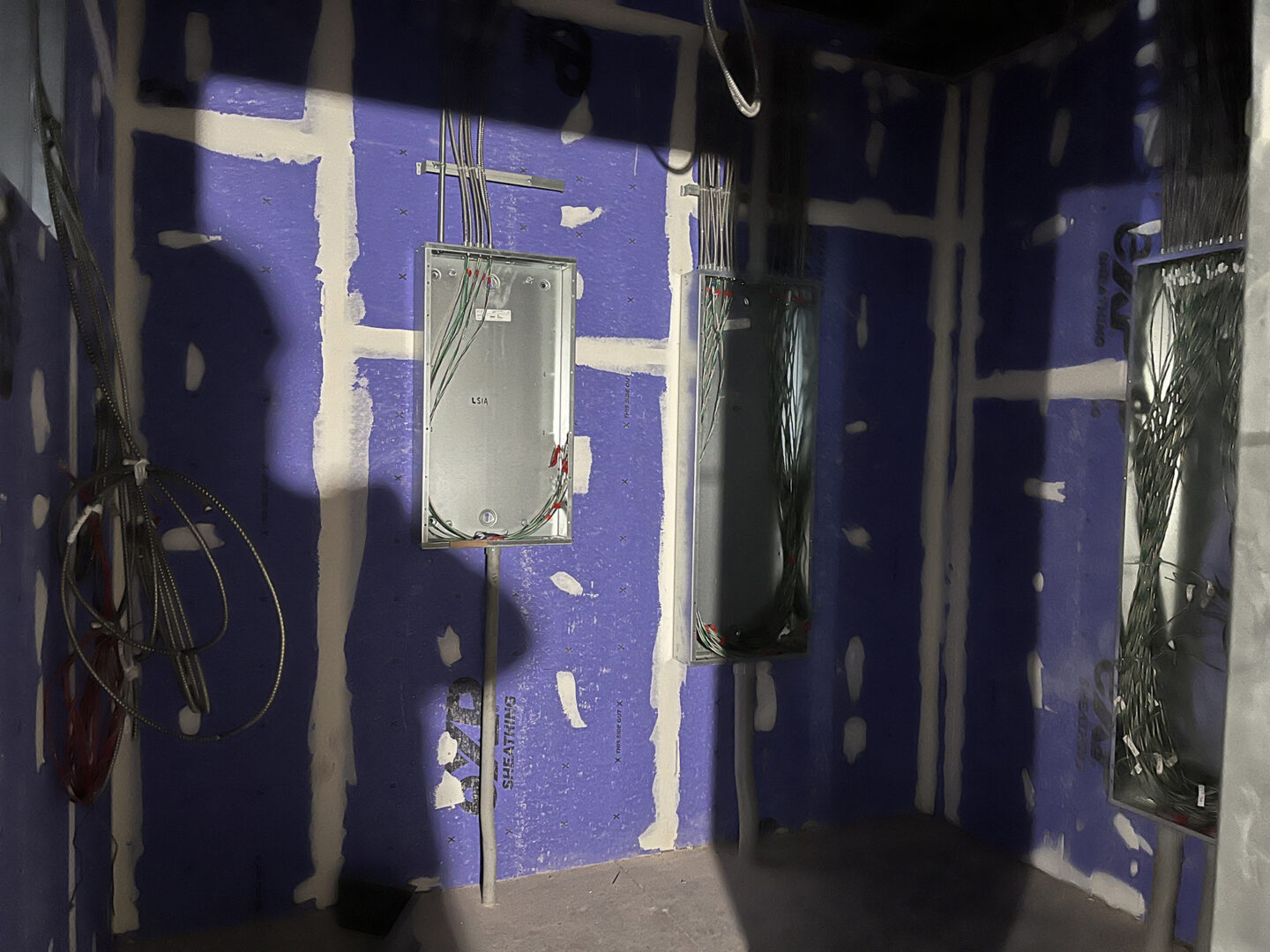

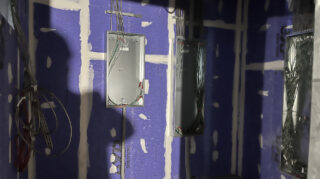

  • Electrical rough-in – 15% complete
  • Plumbing rough-in – 20% complete

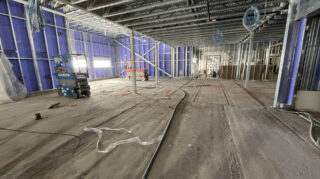

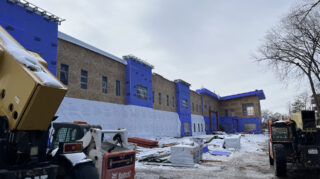

  • Second-floor concrete pour – 100% complete

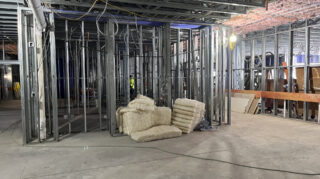

  • Second-floor wall installation – 40% complete

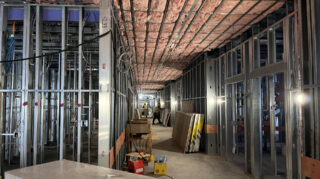

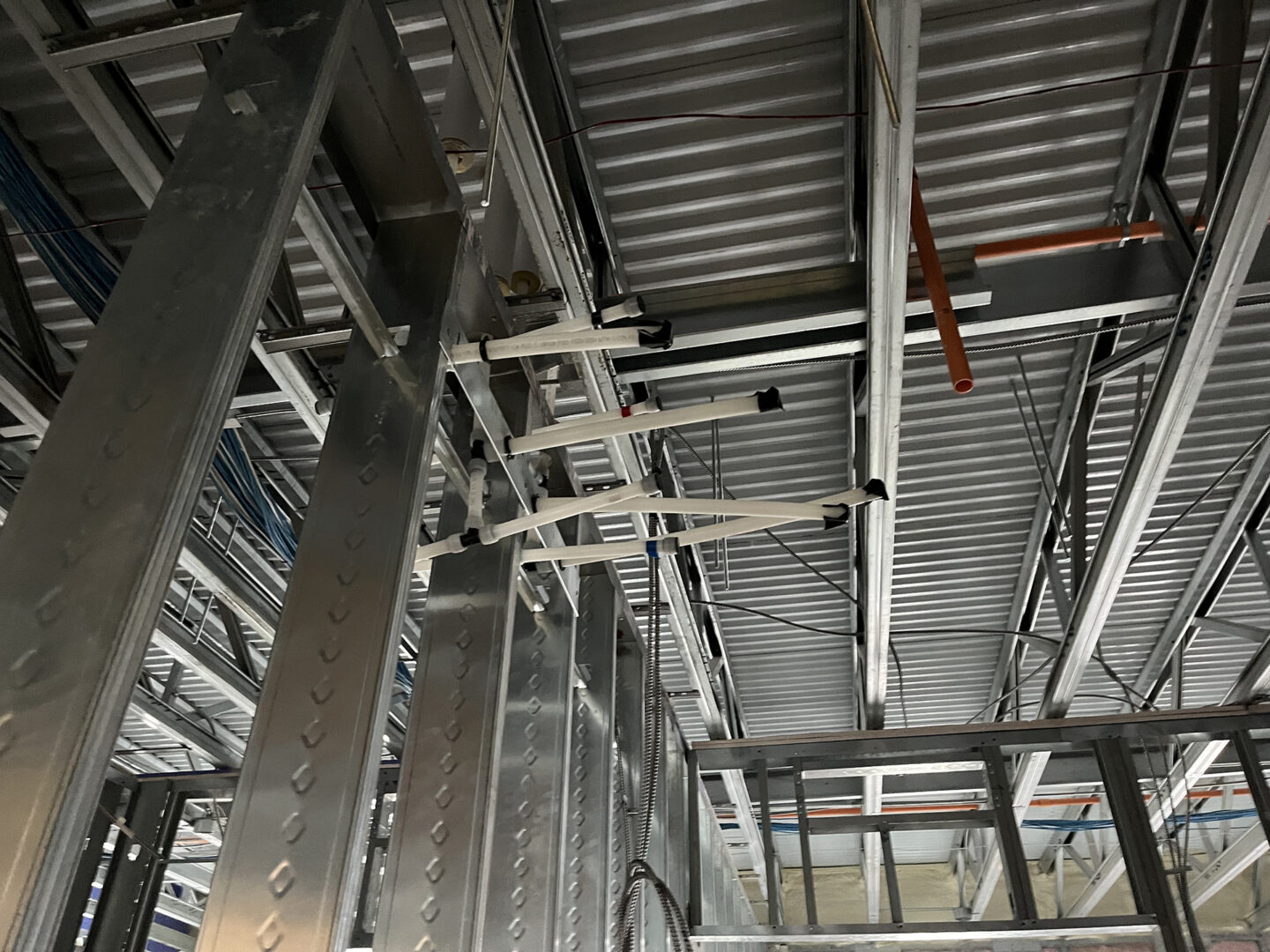

  • Roof framing – 10% complete

Over the coming weeks and months, the project will move into several critical phases:

  • Roof framing

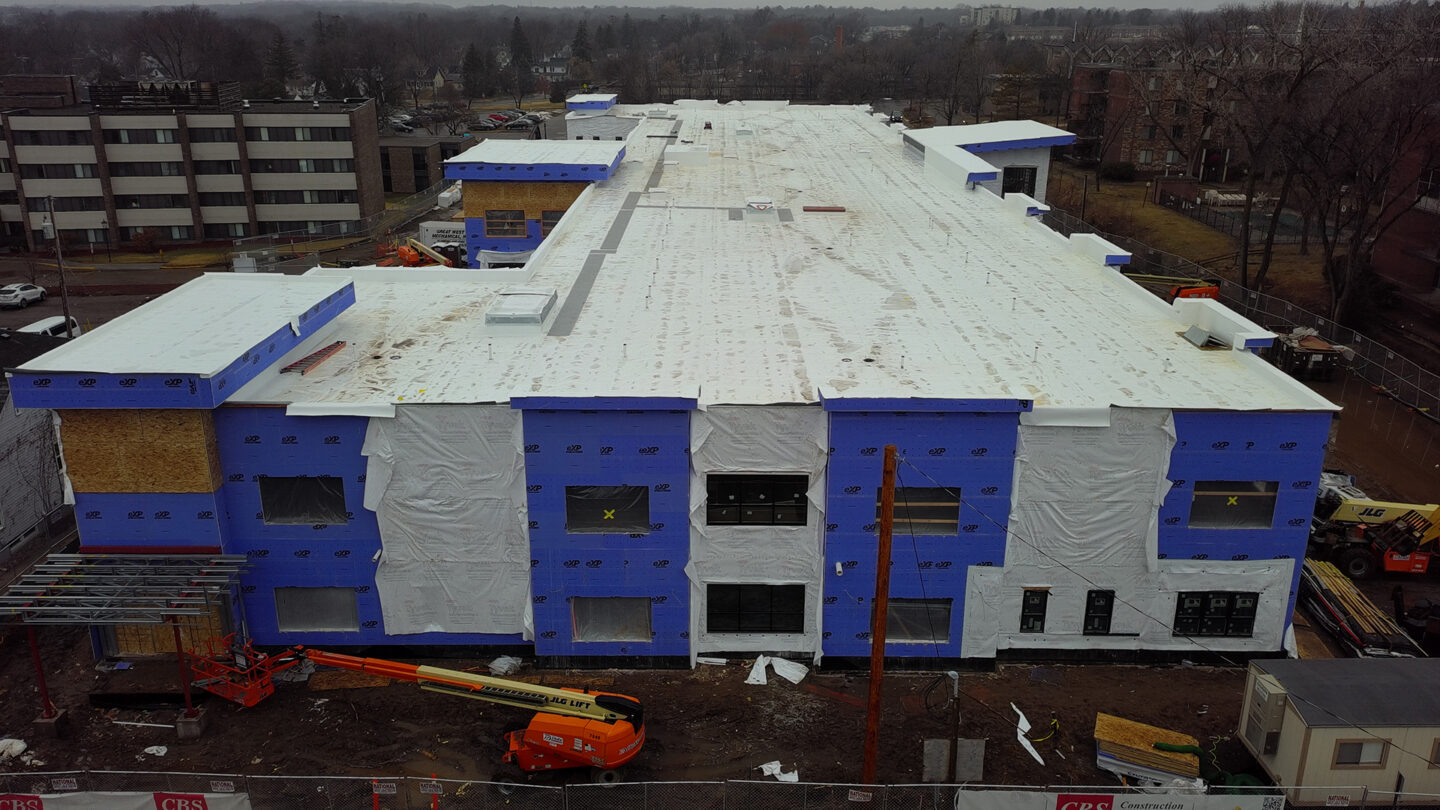

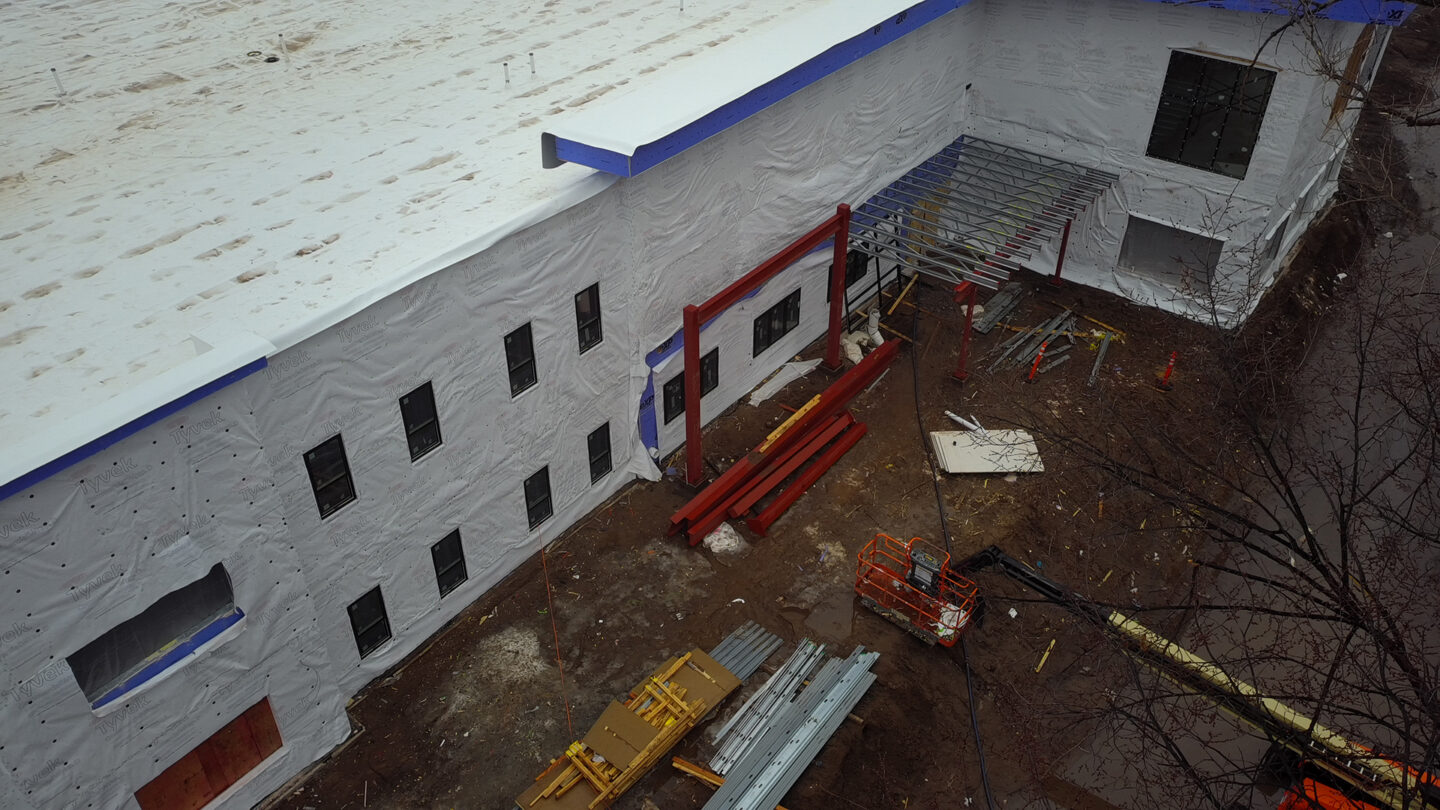

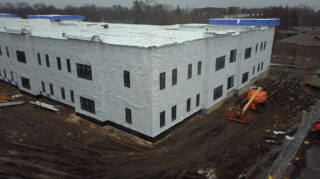

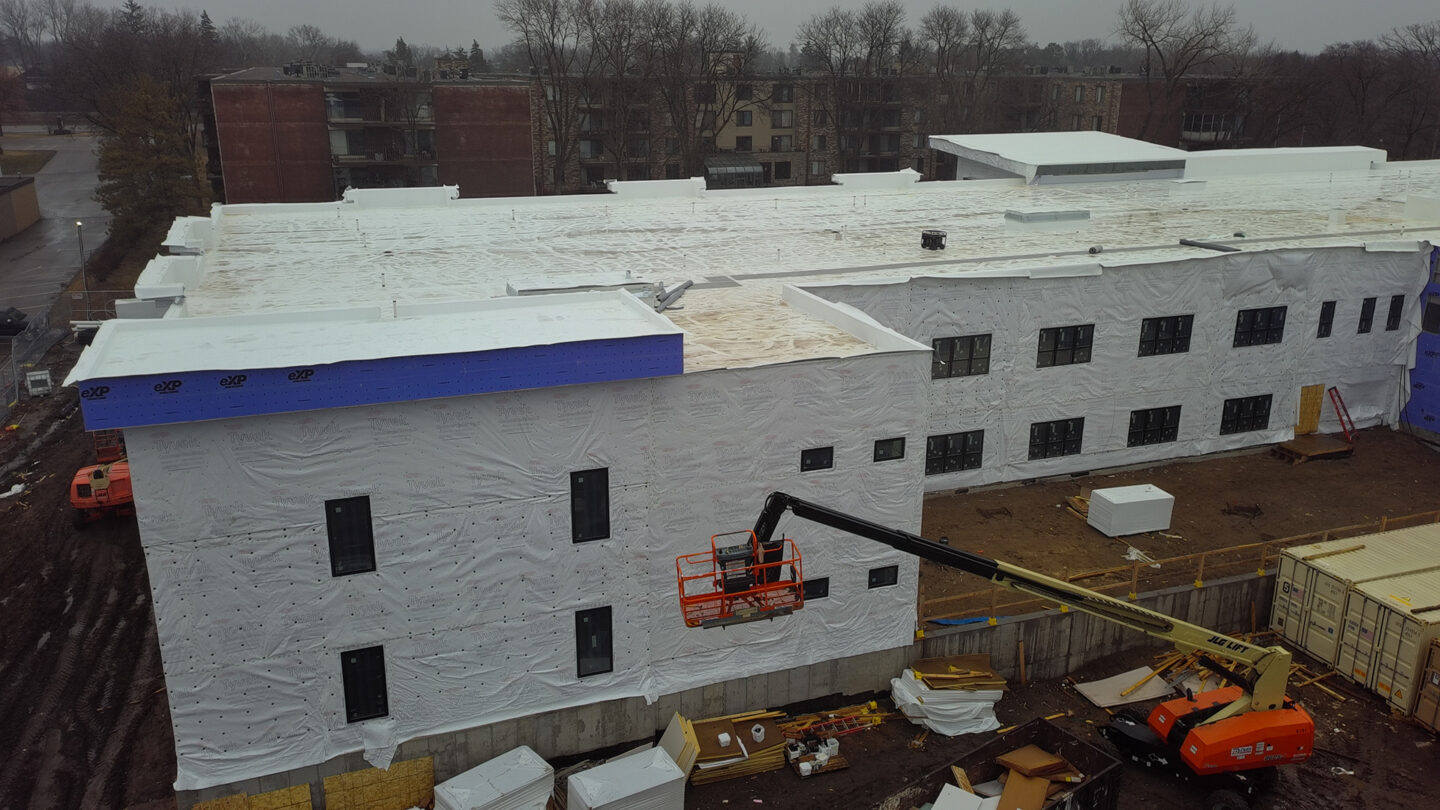

  • Roof and roof membrane installation

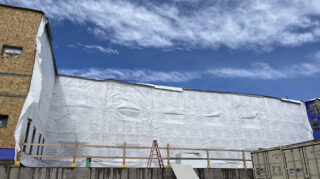

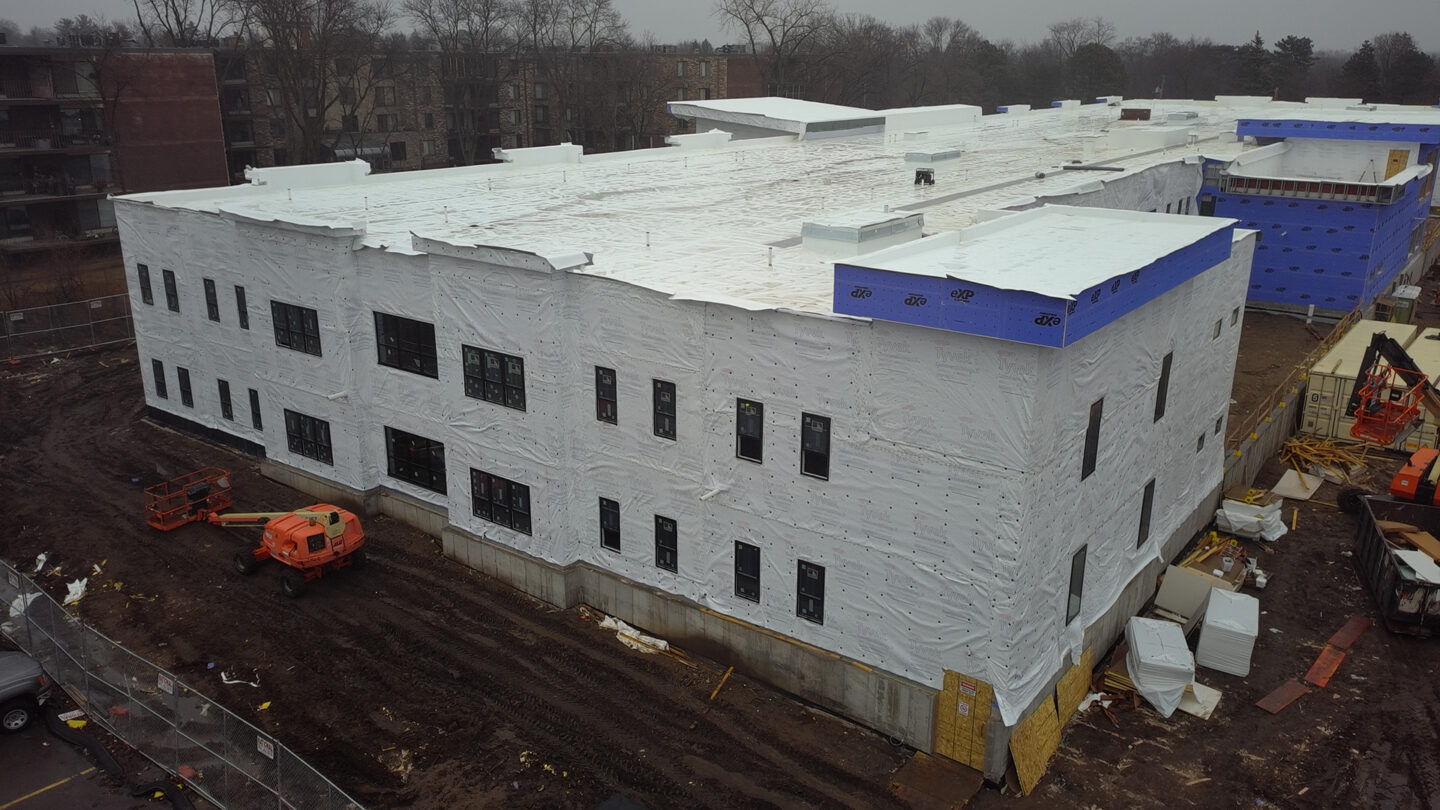

  • Window installation

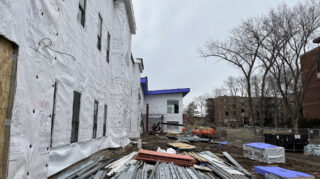

  • Vapor barrier installation

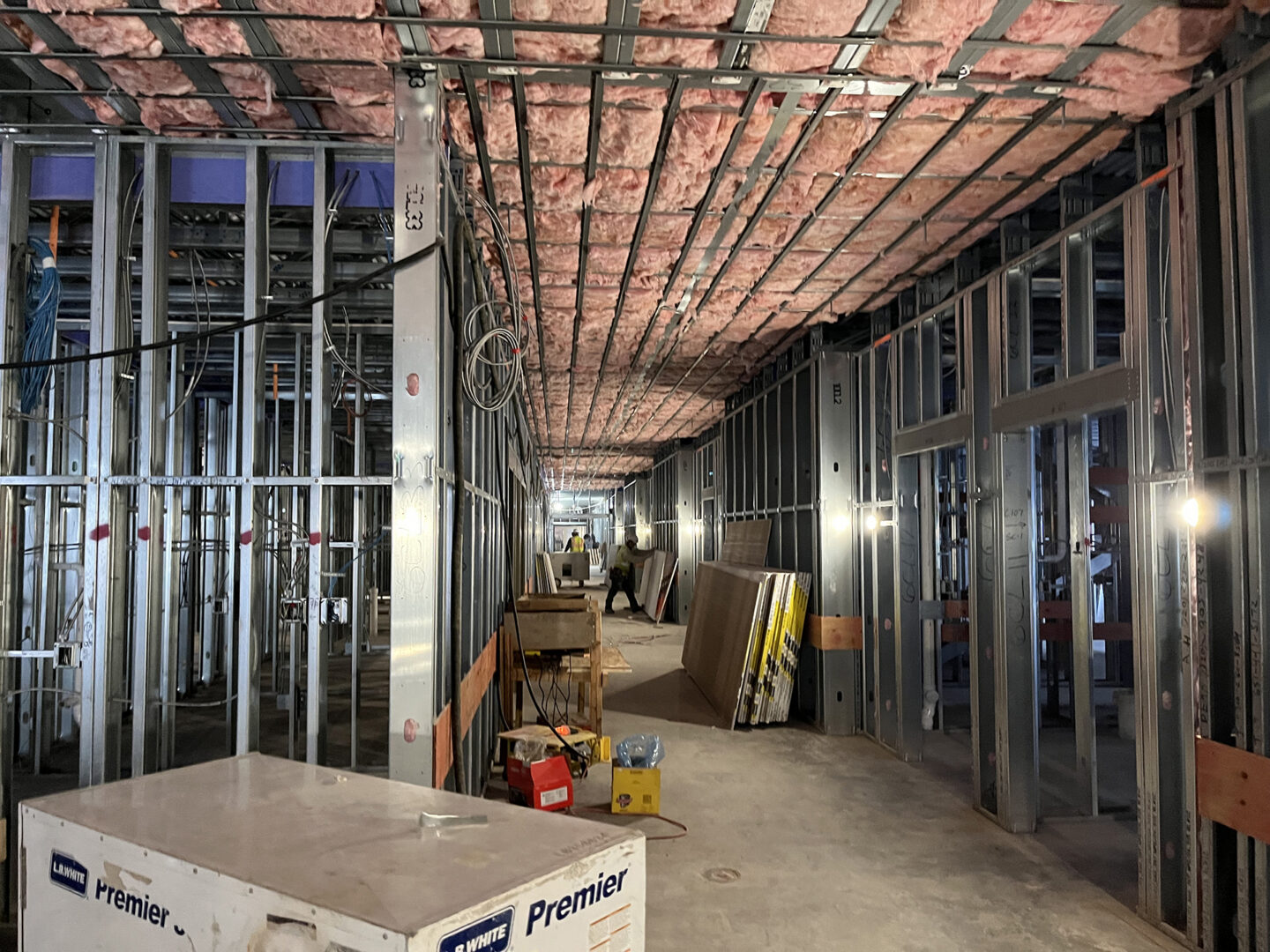

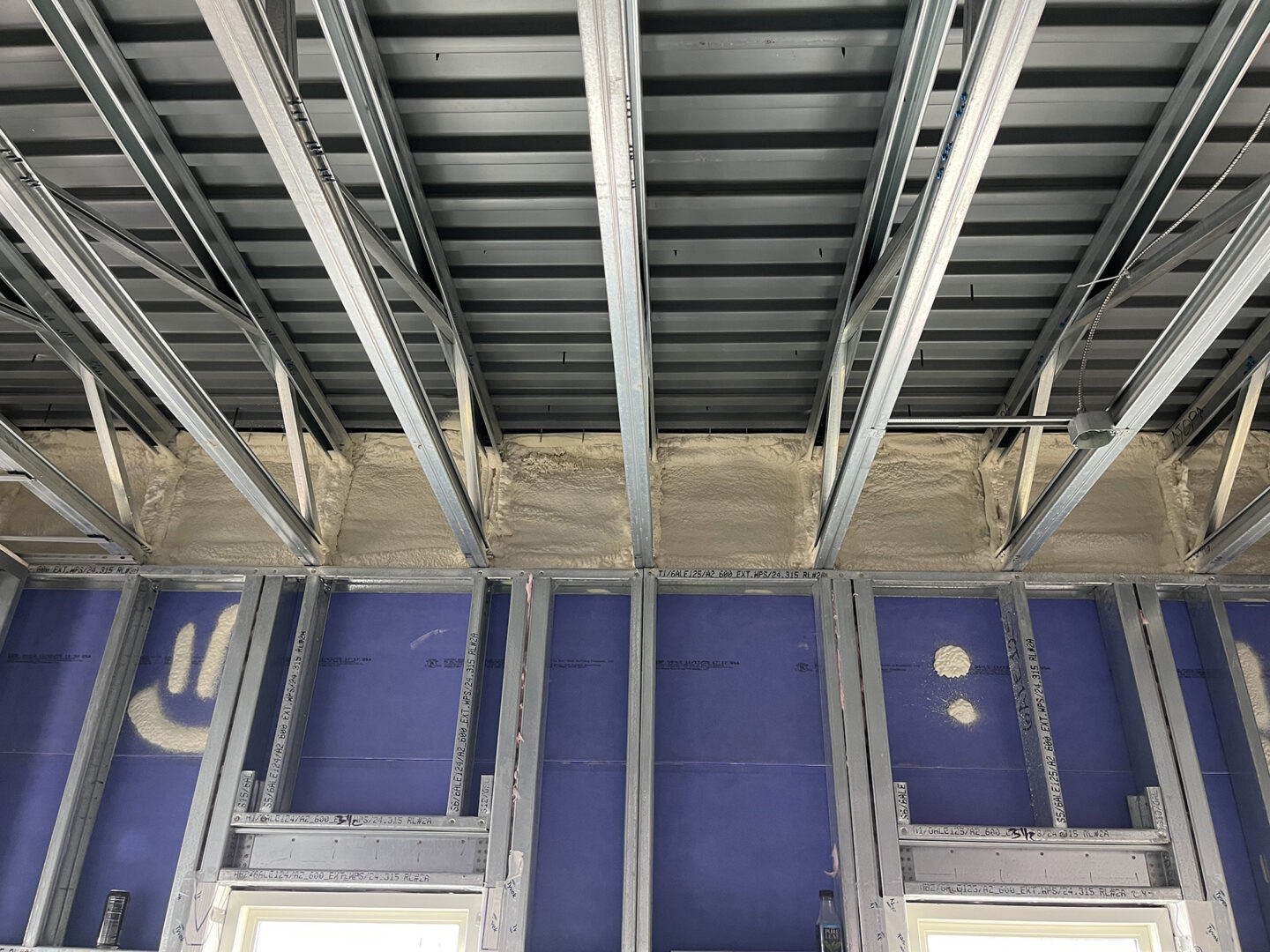

  • Insulation installation

Construction Schedule

CBS Construction continues to track for substantial completion of the project on schedule.


November 2025:

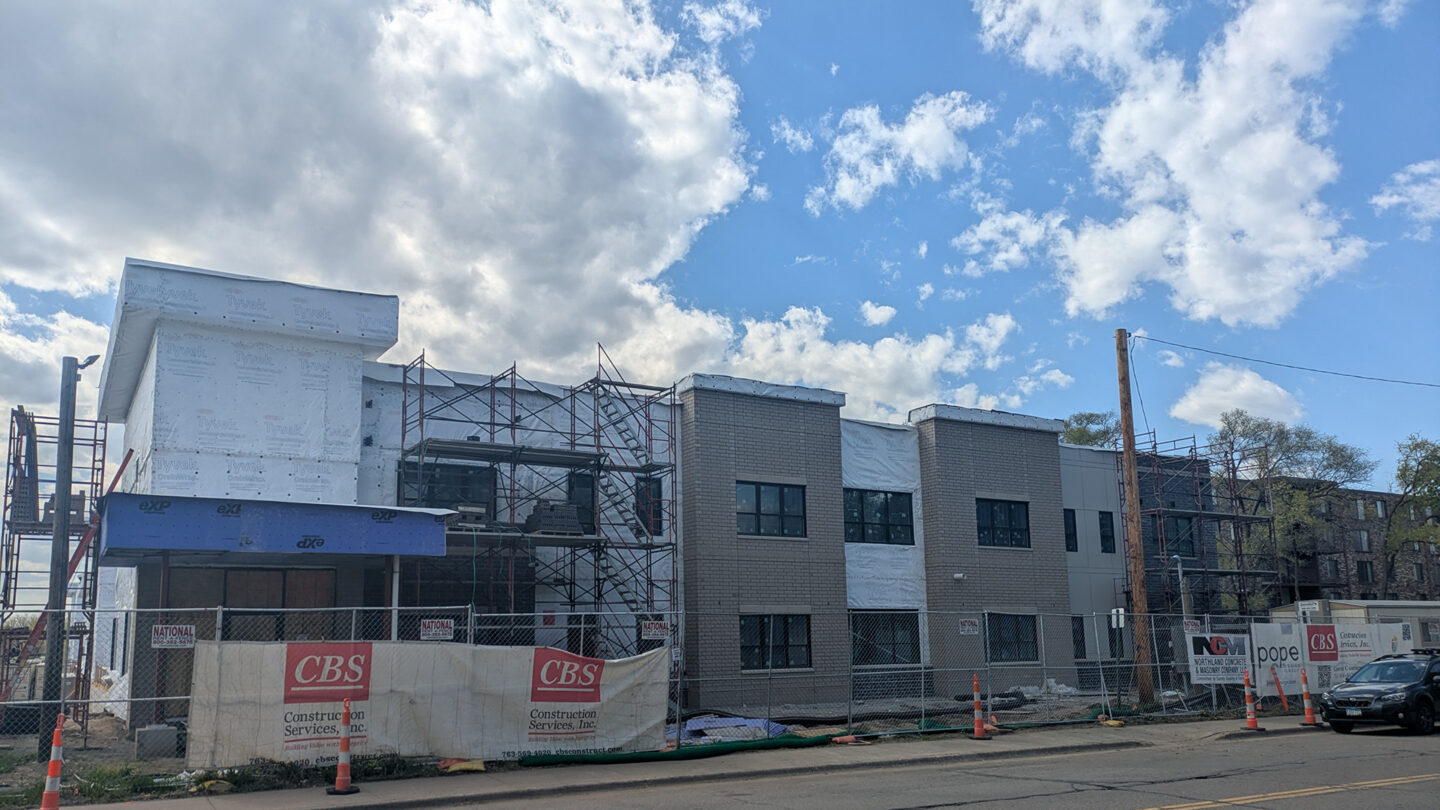

Progress continues on the new Chapel View Health Care Center in Hopkins, MN, where CBS Construction remains on track for a Fall 2026 substantial completion. The team has maintained steady momentum moving into late 2025, with several major milestones underway.

As of November, construction efforts have focused on structure, framing, and preparation for upper-level work. Key activities currently in progress include:

  • First-floor wall installation – 60% Complete
    Installation continues to advance from west to east as the building’s main-level structure takes shape.

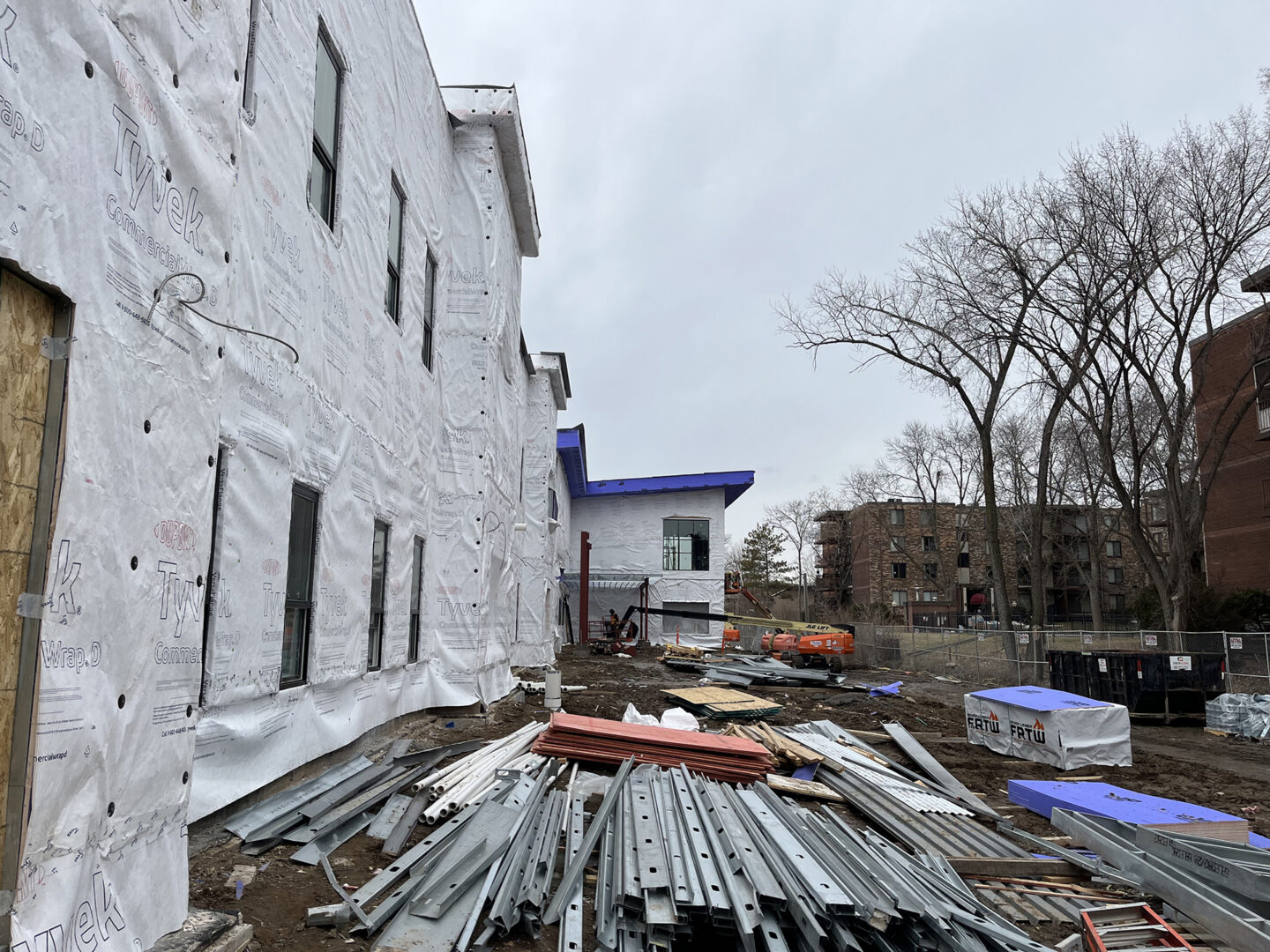

  • Exterior sheathing – 20% Complete

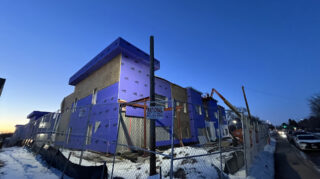

    Initial sheathing installation has begun, providing early enclosure and supporting future weatherproofing.

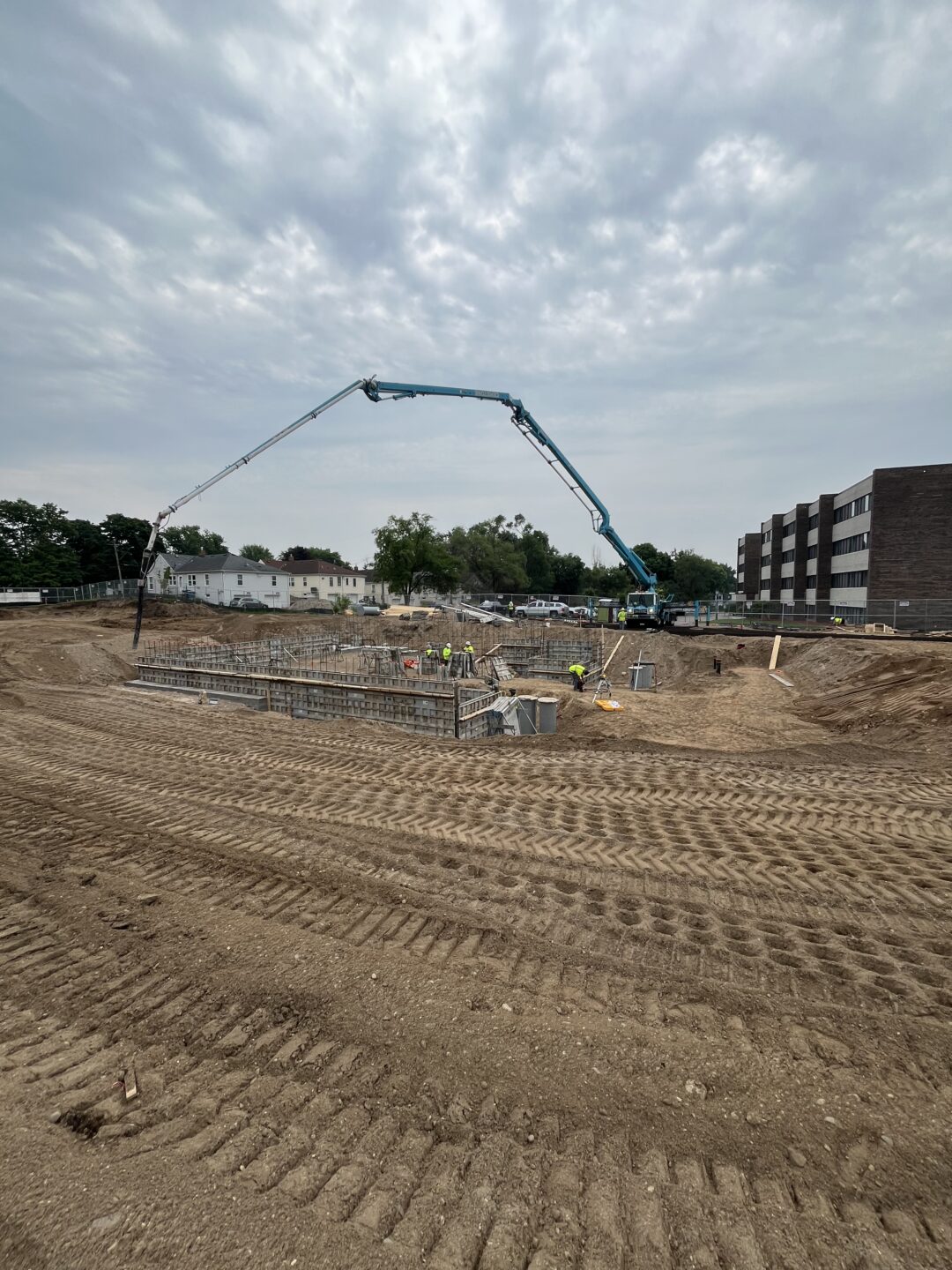

  • Second-floor concrete pour – 20% Complete
  • Work is underway to prep and pour the second-floor slab, a prerequisite for upper-level wall installation and future roof work.

Over the coming weeks and months, the project will move into several critical phases:

  • Second-floor wall installation: Wall panels for the upper level are already staged onsite and will be set shortly after the concrete pour is completed.
  • Roof framing: As second-floor walls progress from west to east, roof framing will begin in sequence.
  • Roof and membrane installation: One of the project’s primary critical-path items, the full roof system is scheduled for installation in early 2026.

CBS Construction continues to track on schedule with no shifts to the anticipated completion timeline. The strong coordination between teams and proactive planning around weather and material readiness have kept the project advancing smoothly.

We look forward to sharing continued progress as Chapel View moves toward a revitalized, modern care environment for residents and the greater Hopkins community.
